West Bengal Housing Industry Regulatory Authority

WBHIRA

Project Status as on Quarter ending 31-03-2021
Updated as on 25-03-2021

Booking Status

  • Residential Apartments Booked
    0

  • Basement Parking Booked
    Not mentioned

  • Open Car Parking Booked
    Not mentioned

  • Covered Car Parking Booked
    Not mentioned

  • Mechanical Parking Booked
    Not mentioned

Status of construction of each building/floor with photographs

Block/Building Floor Construction Status Download

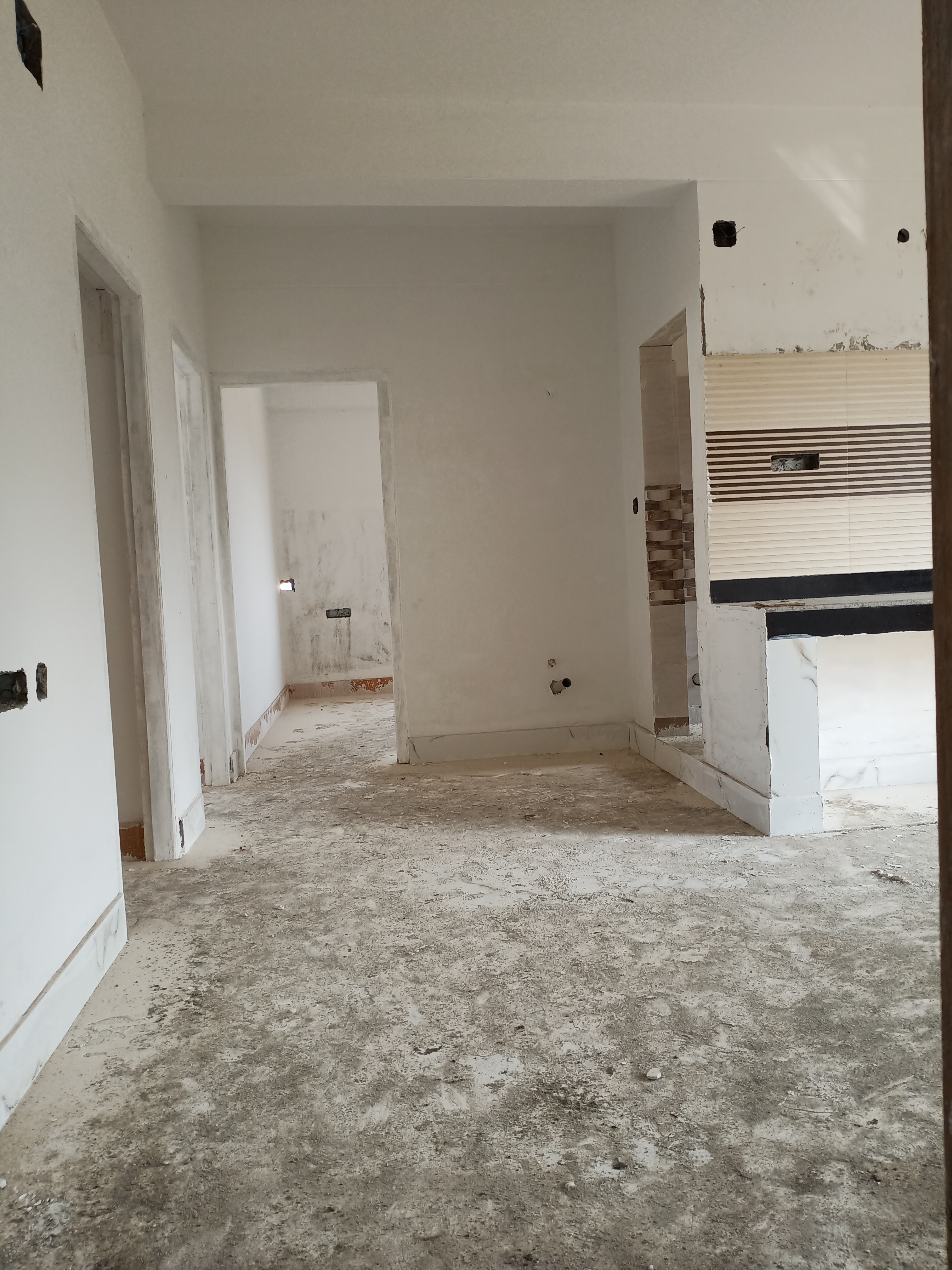

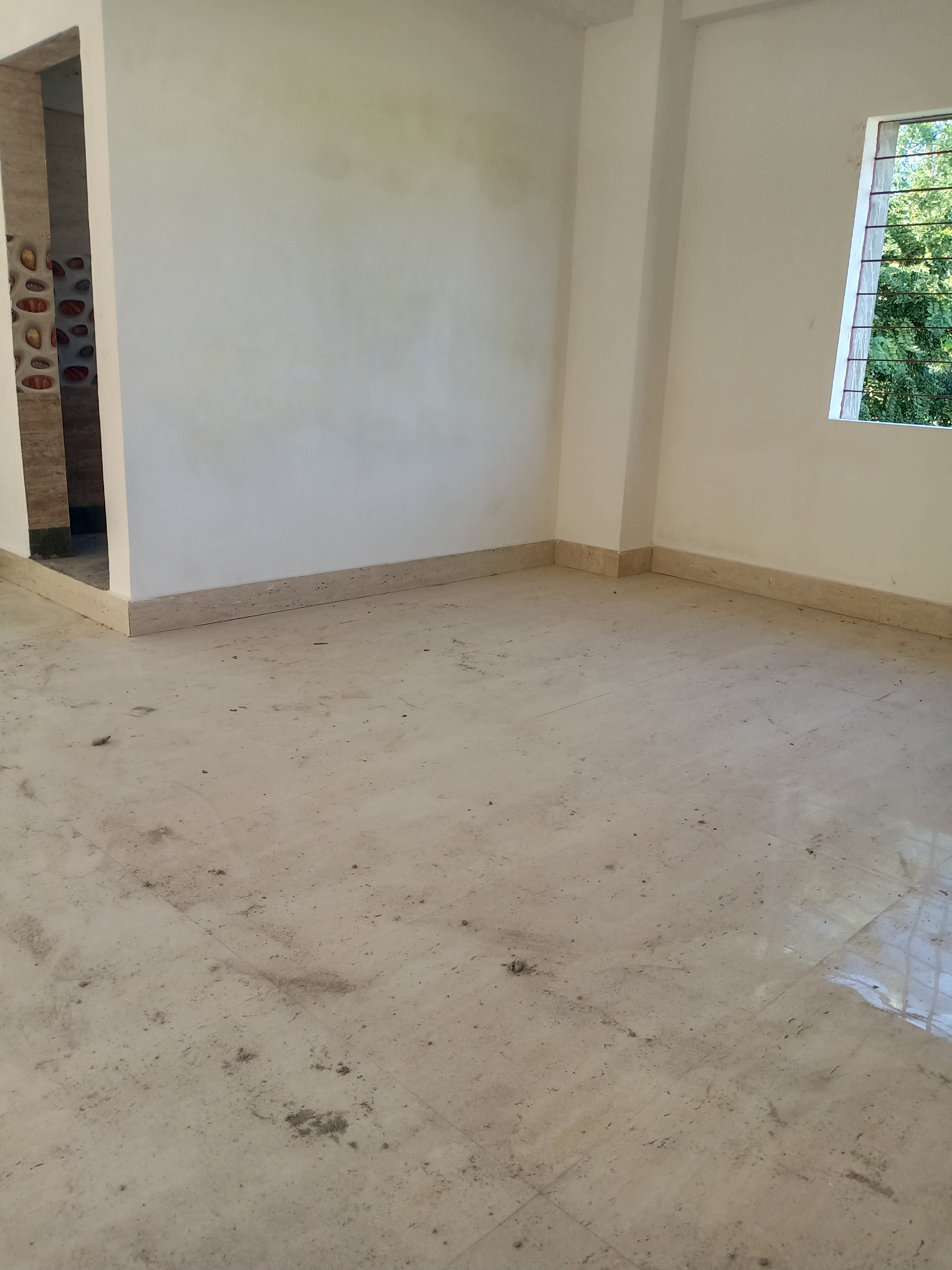

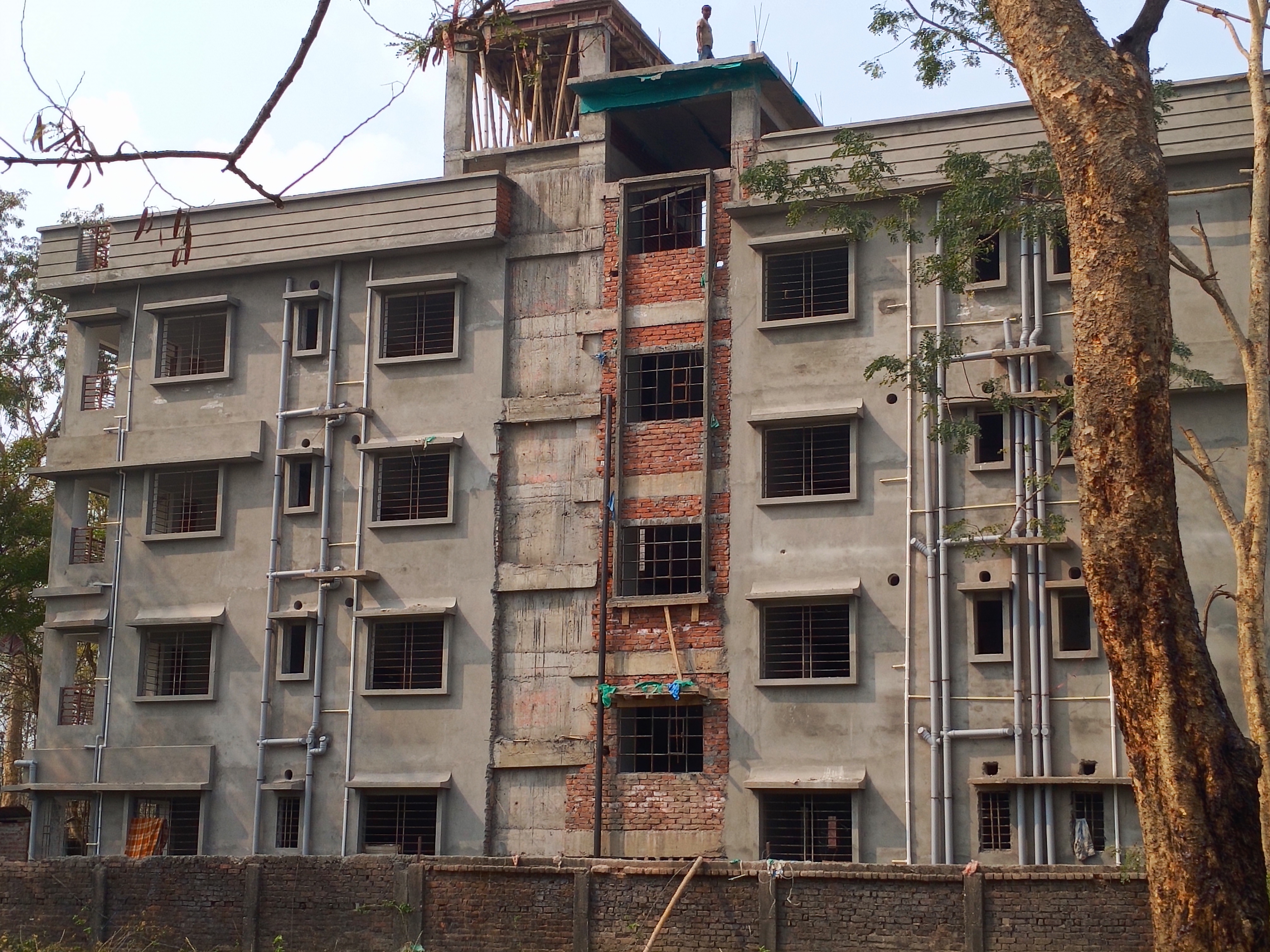

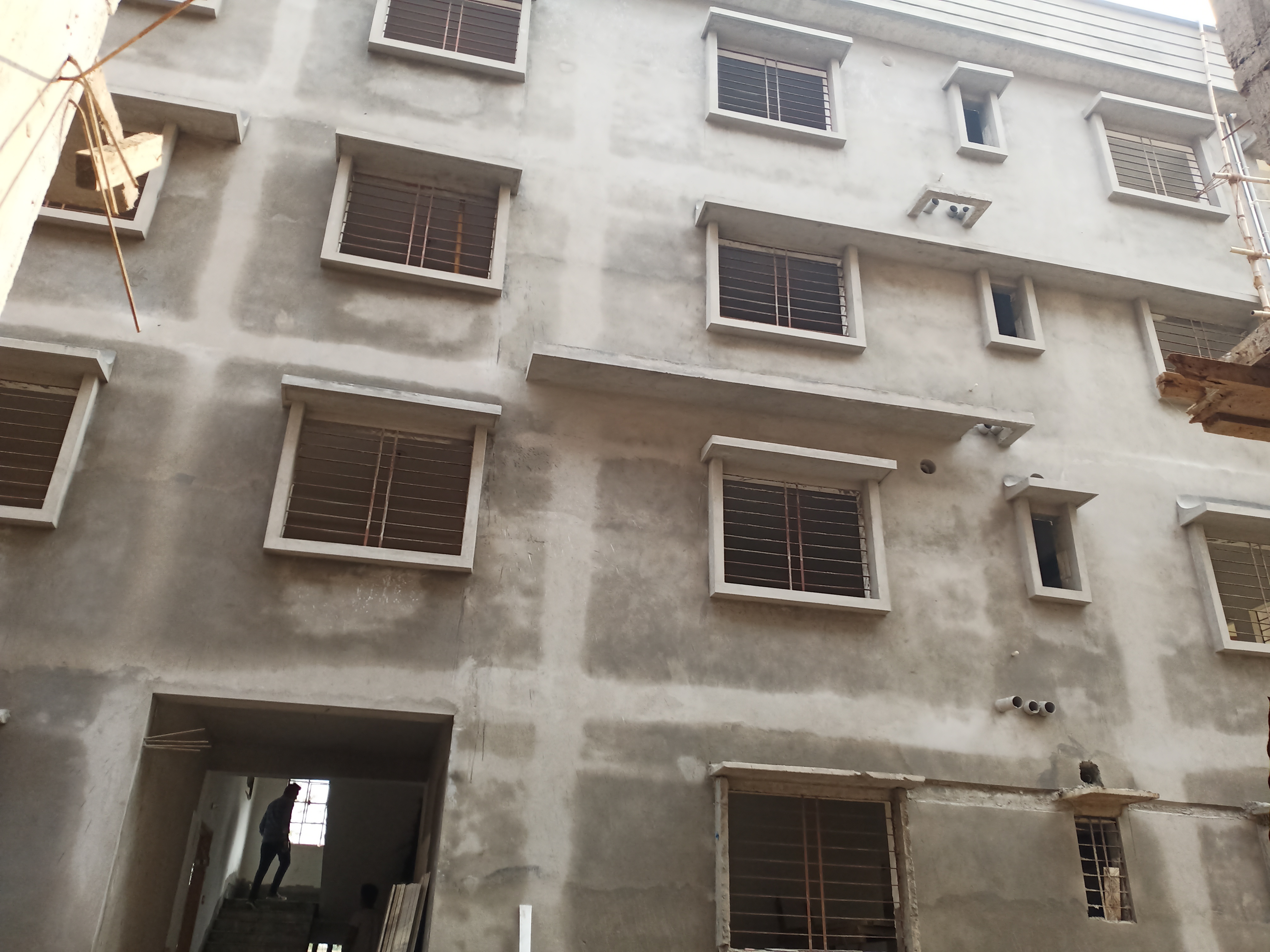

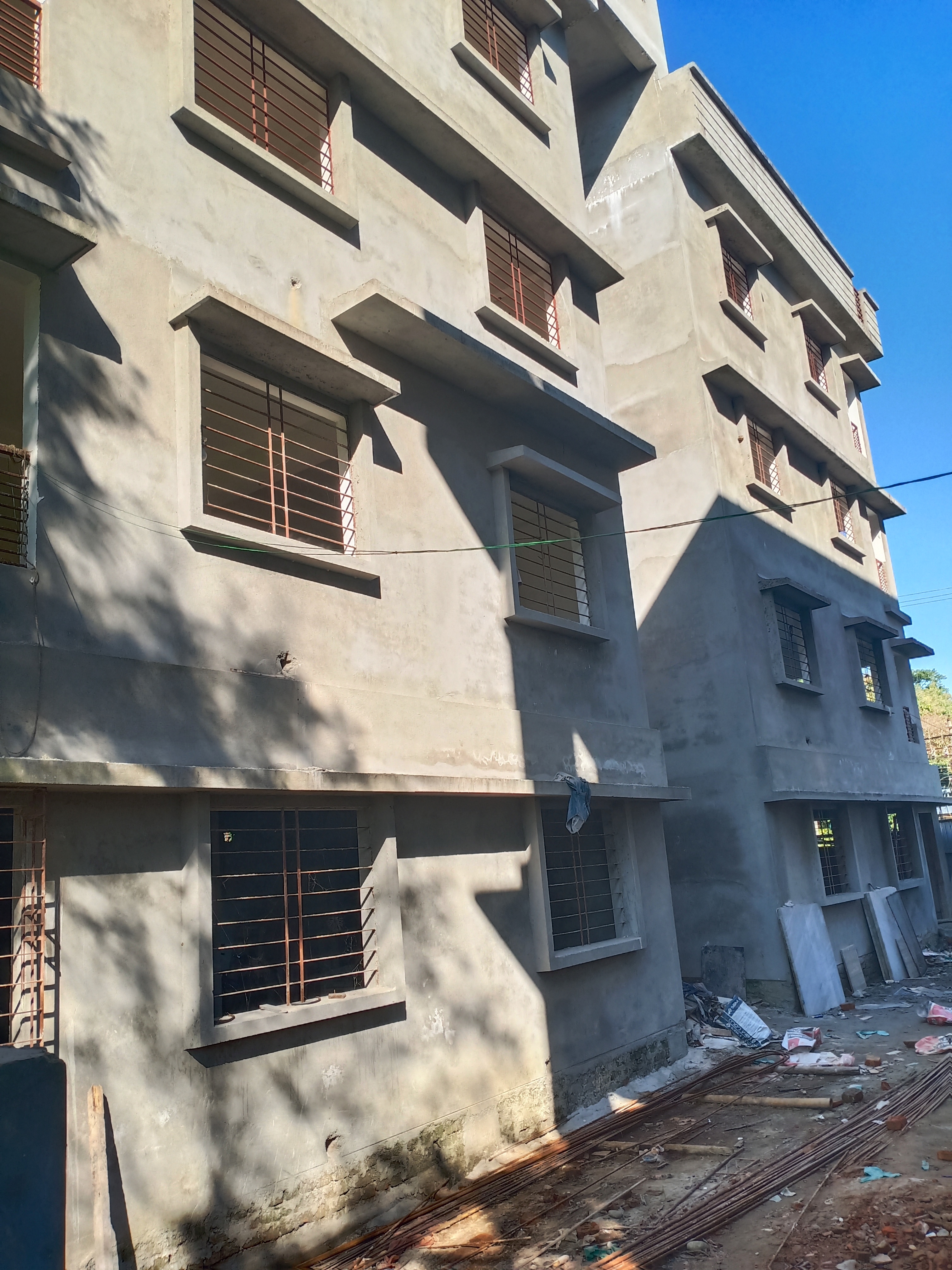

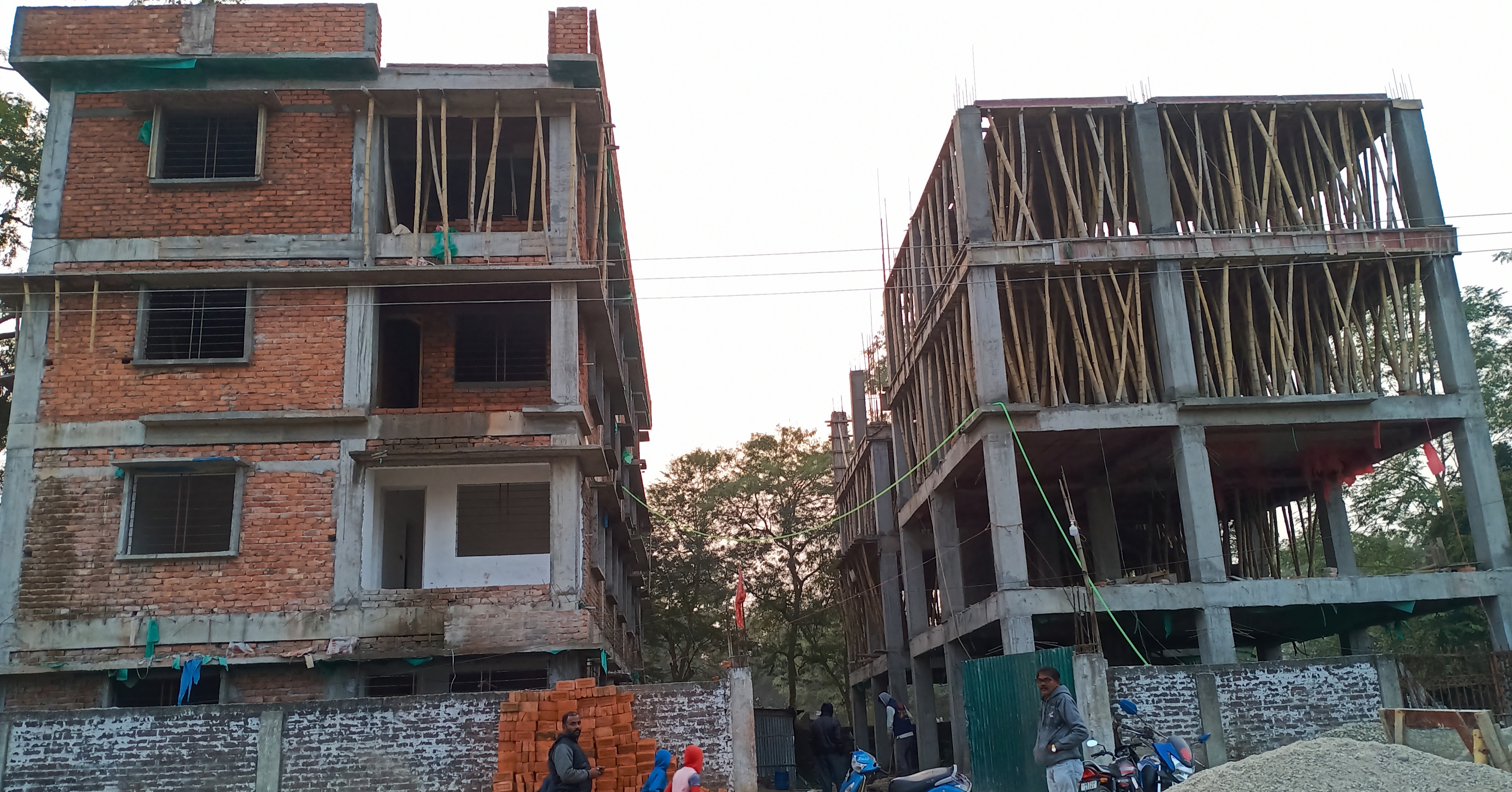

BLOCK - A 4 Under Construction

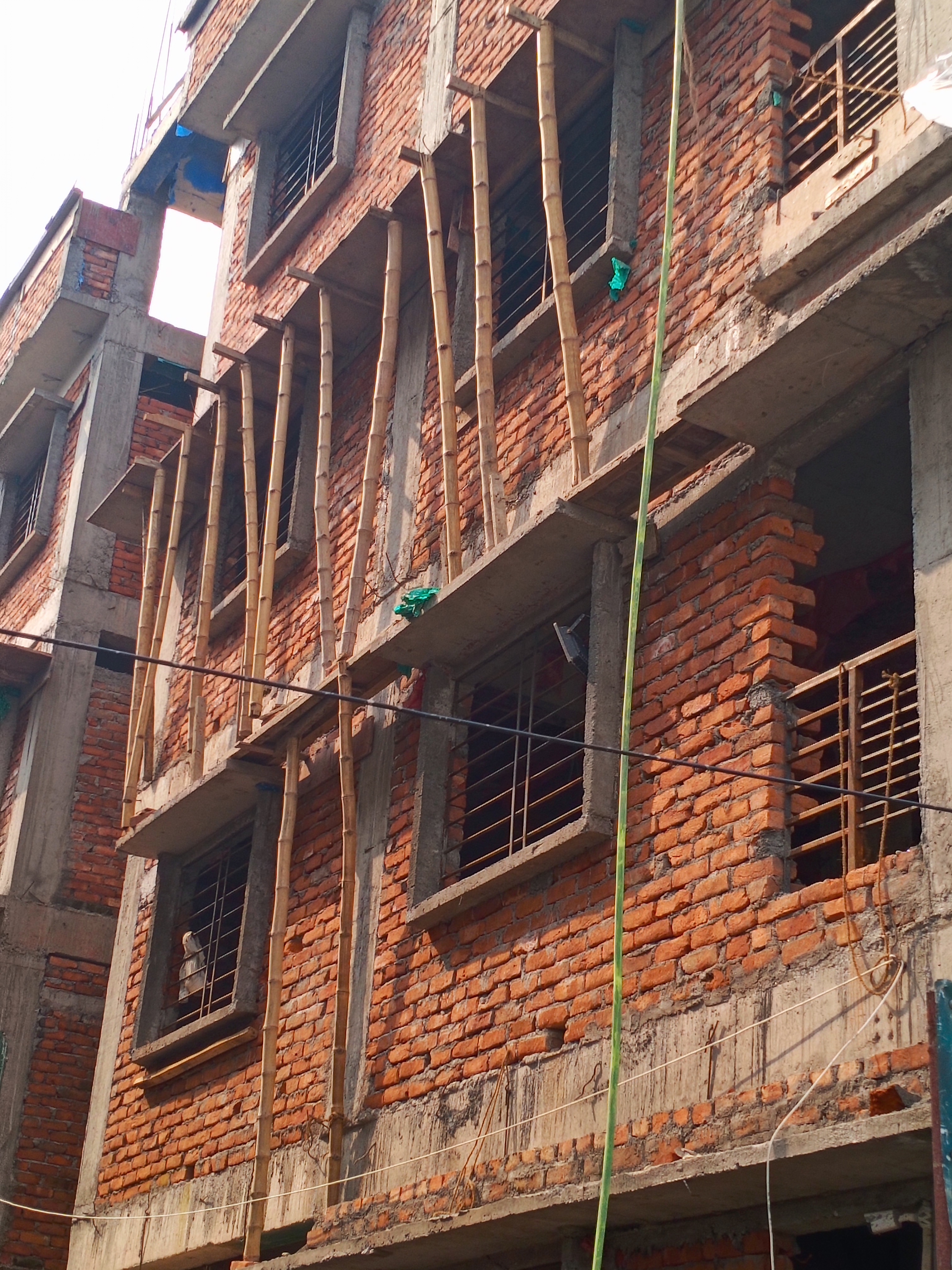

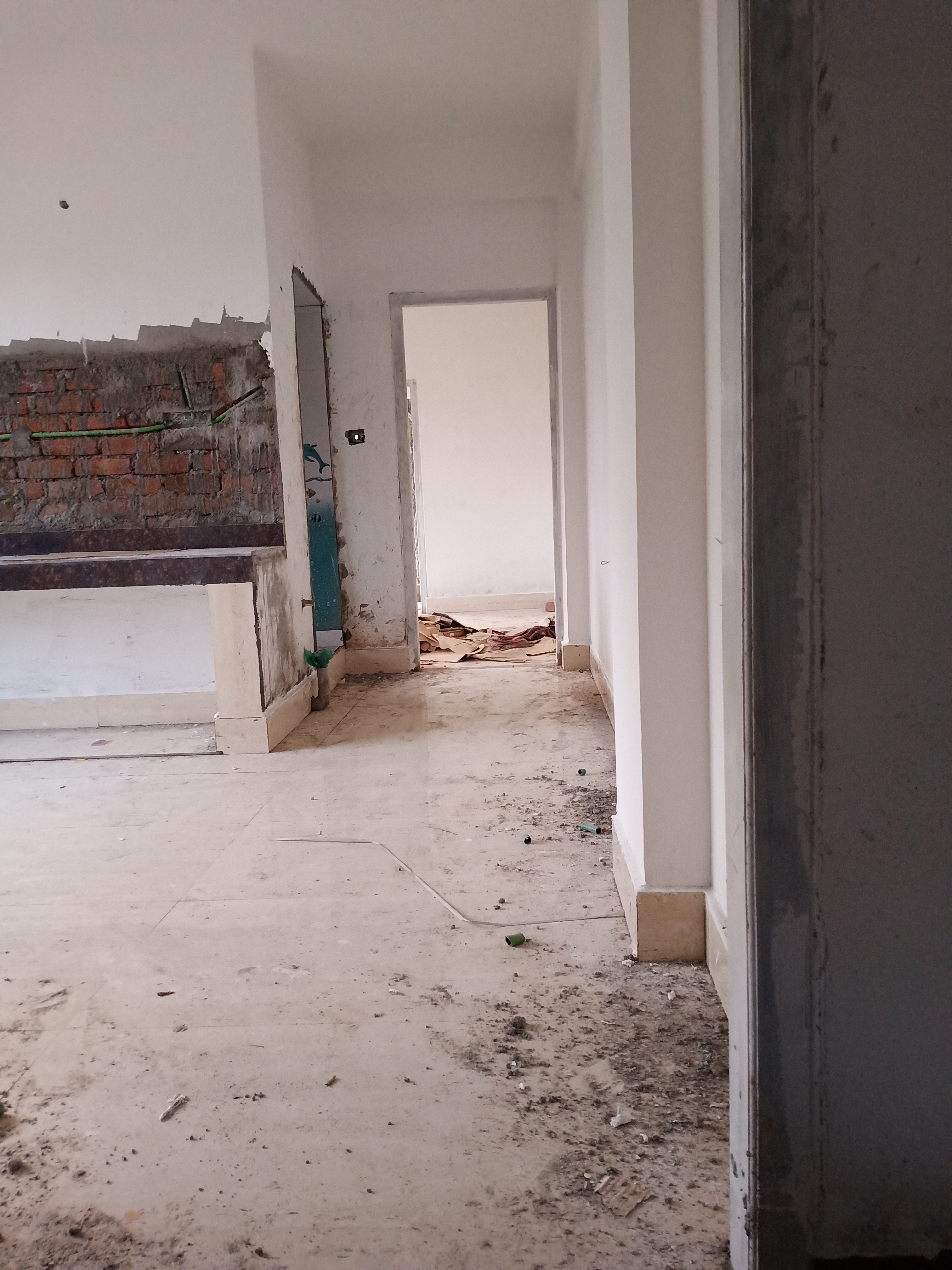

BLOCK - B 2 Under Construction

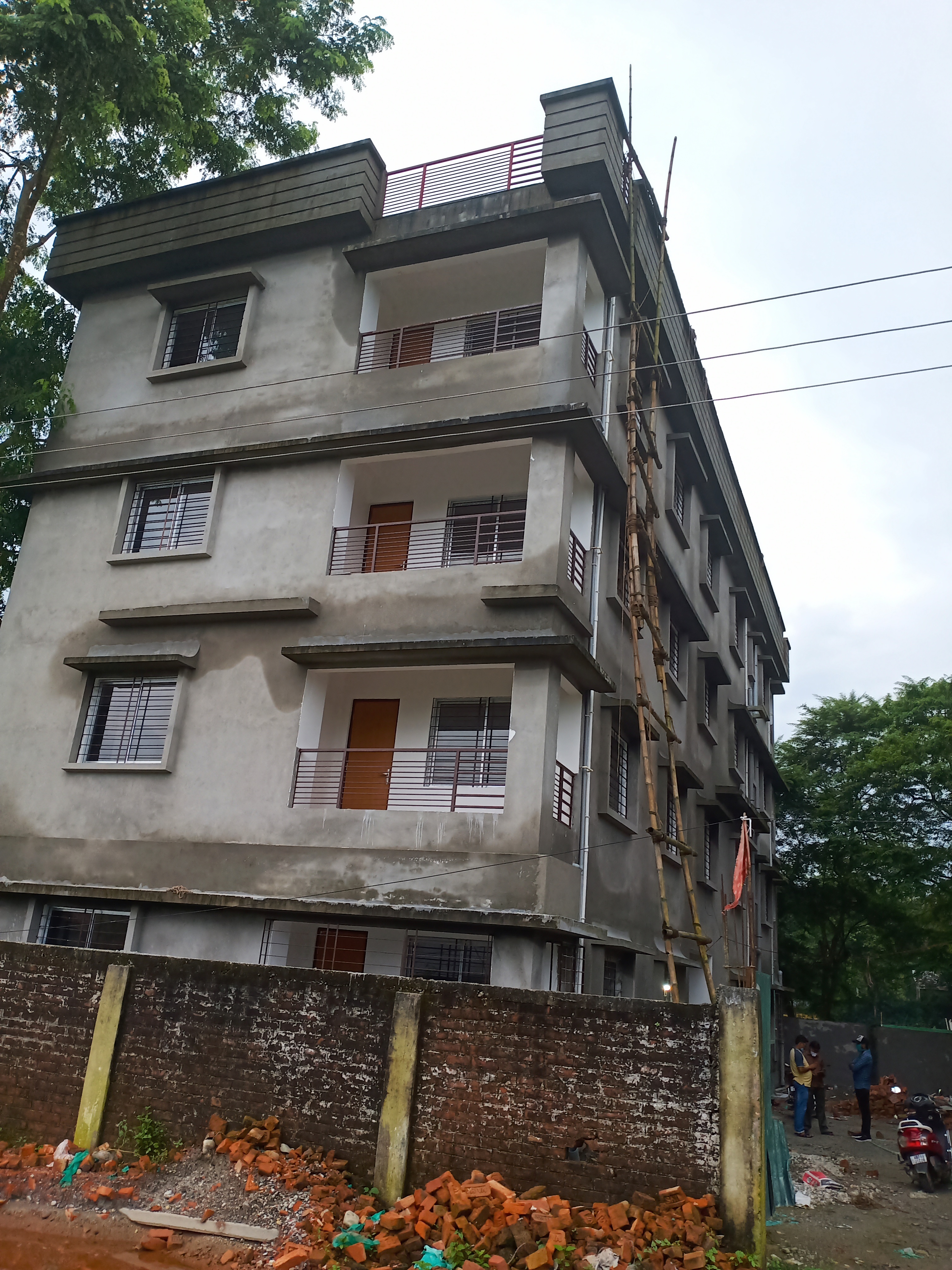

BLOCK - A 4 Under Construction

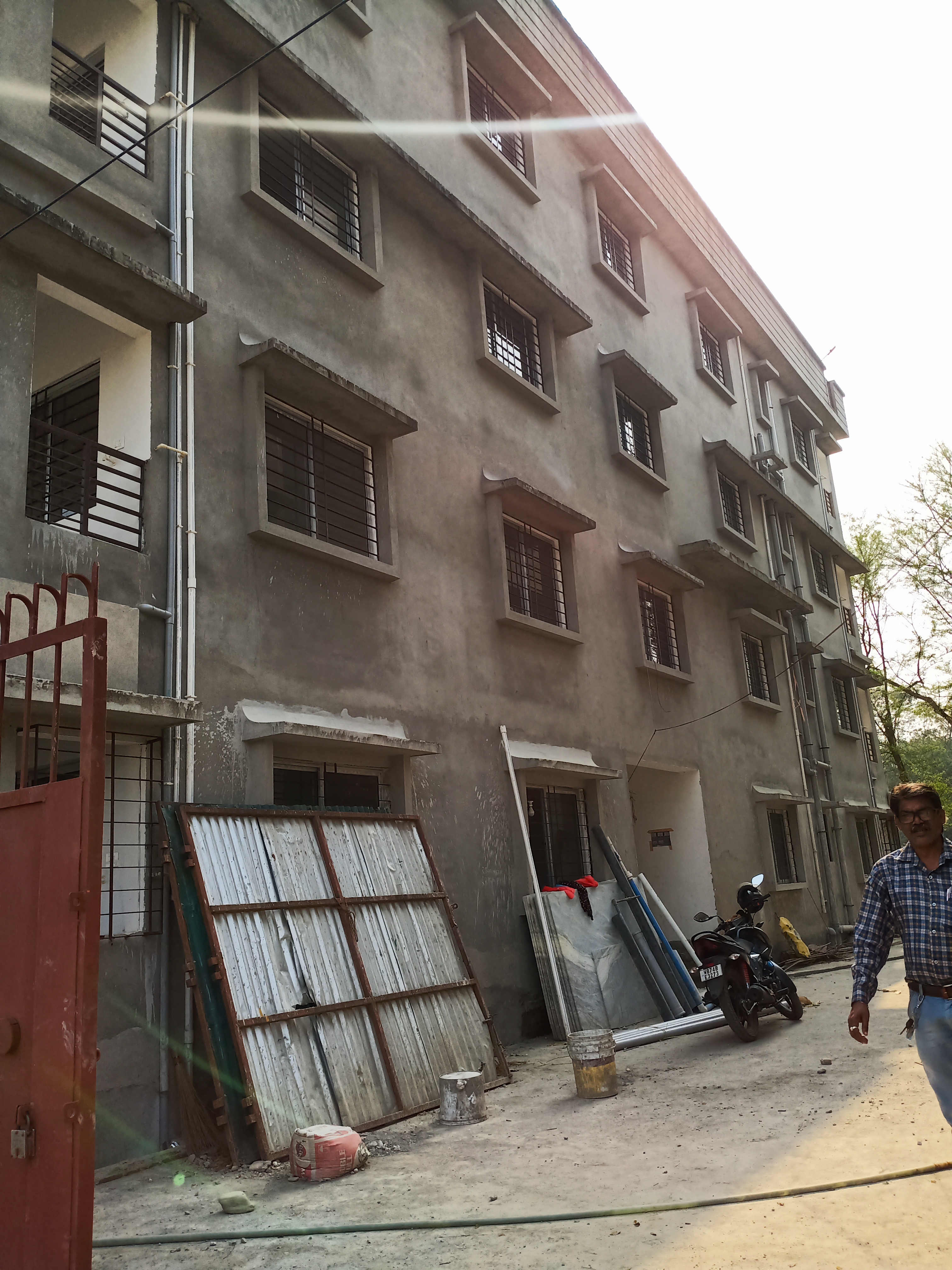

BLOCK - A 1 Under Construction

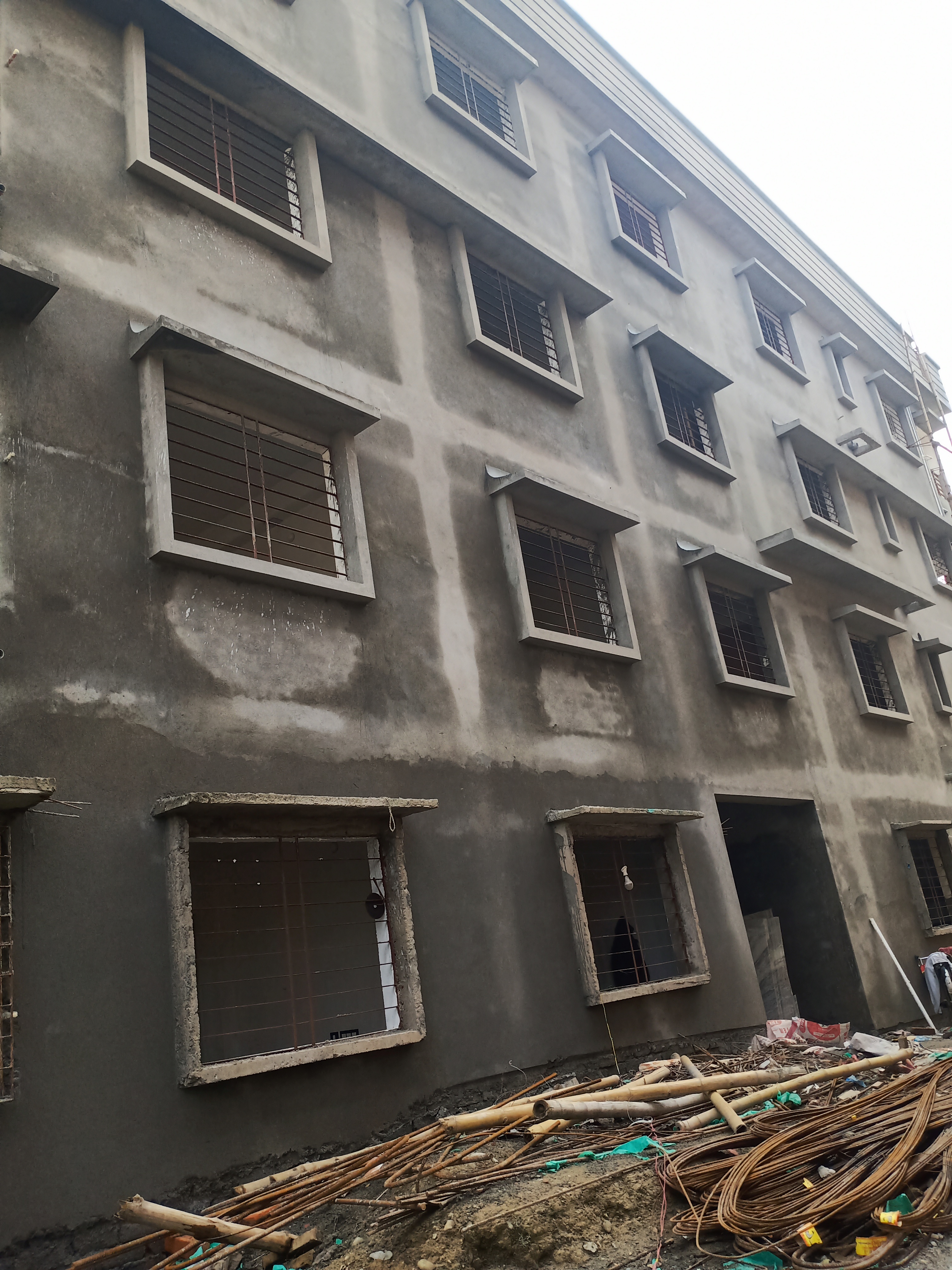

BLOCK - B 1 Under Construction
BLOCK - A 1 Under Construction
BLOCK - A 2 Under Construction
BLOCK - A 3 Under Construction
BLOCK - A 4 Under Construction
BLOCK - A 3 Under Construction
BLOCK - B 1 Under Construction
BLOCK - B 1 Under Construction

Status of Construction of Internal Infrastructure with photographs

Sl No. Title Download

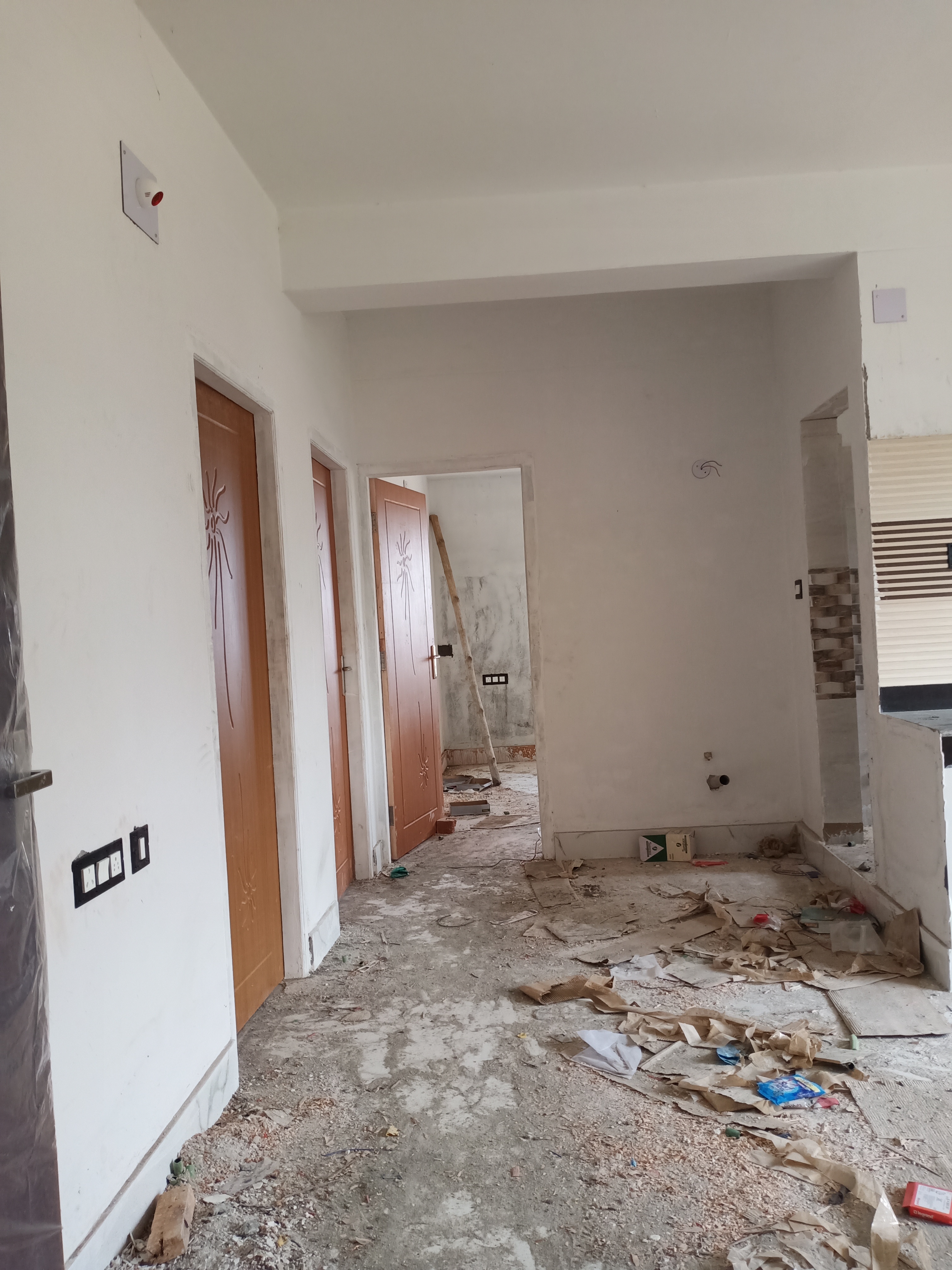

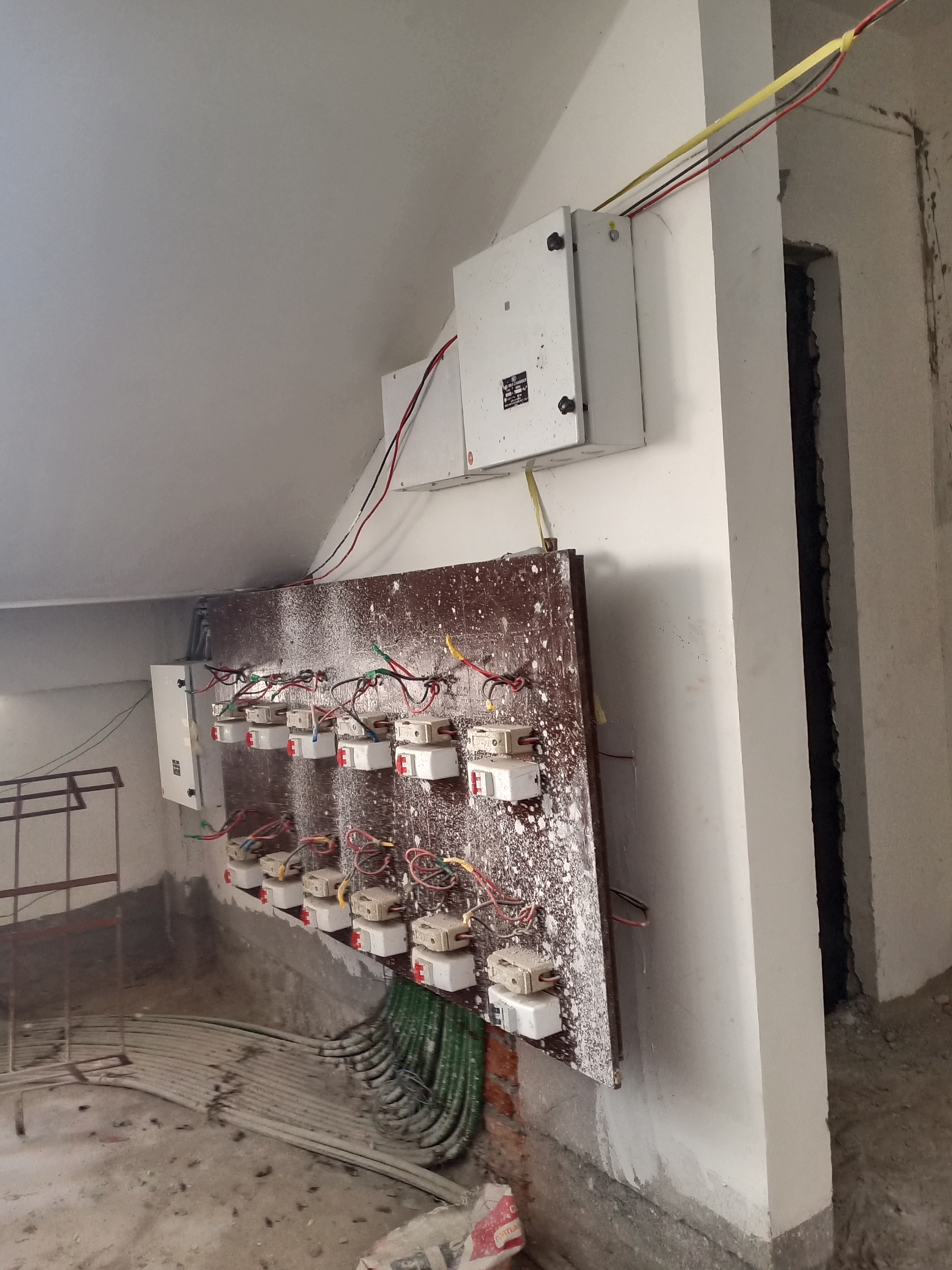

1 BLOCK- A : BRICK WALL OF ALL FLATS HAS BEEN COMPLETED; PLASTERING OF THE INTERIOR OF ALL FLATS HAS BEEN COMPLETED; FLOOR TILES OF ALL FLATS HAS BEEN COMPLETED; ELECTRIC WORK IS UNDER PROCESS; PLUMBING WORK HAS BEEN COMPLETED.

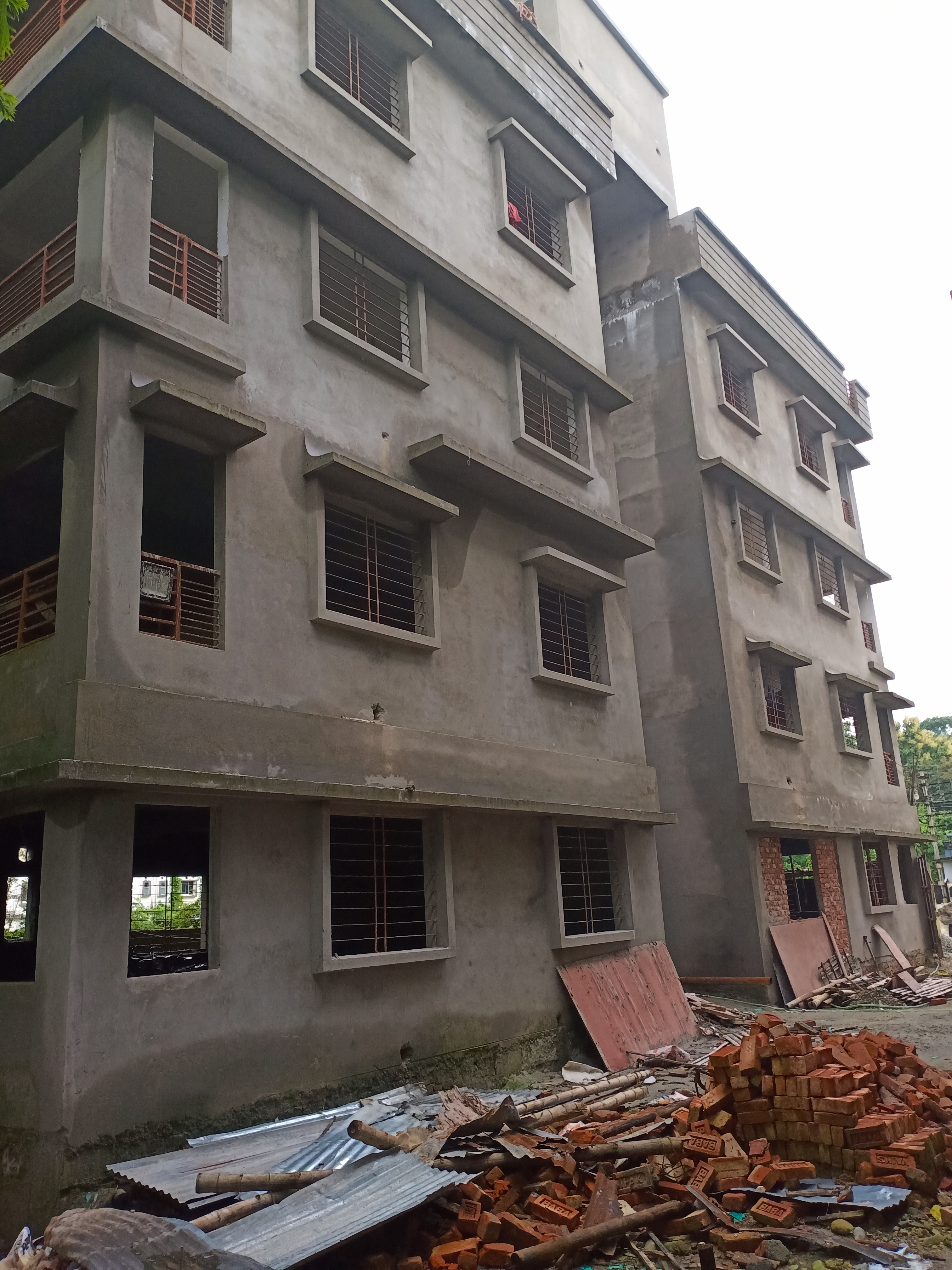

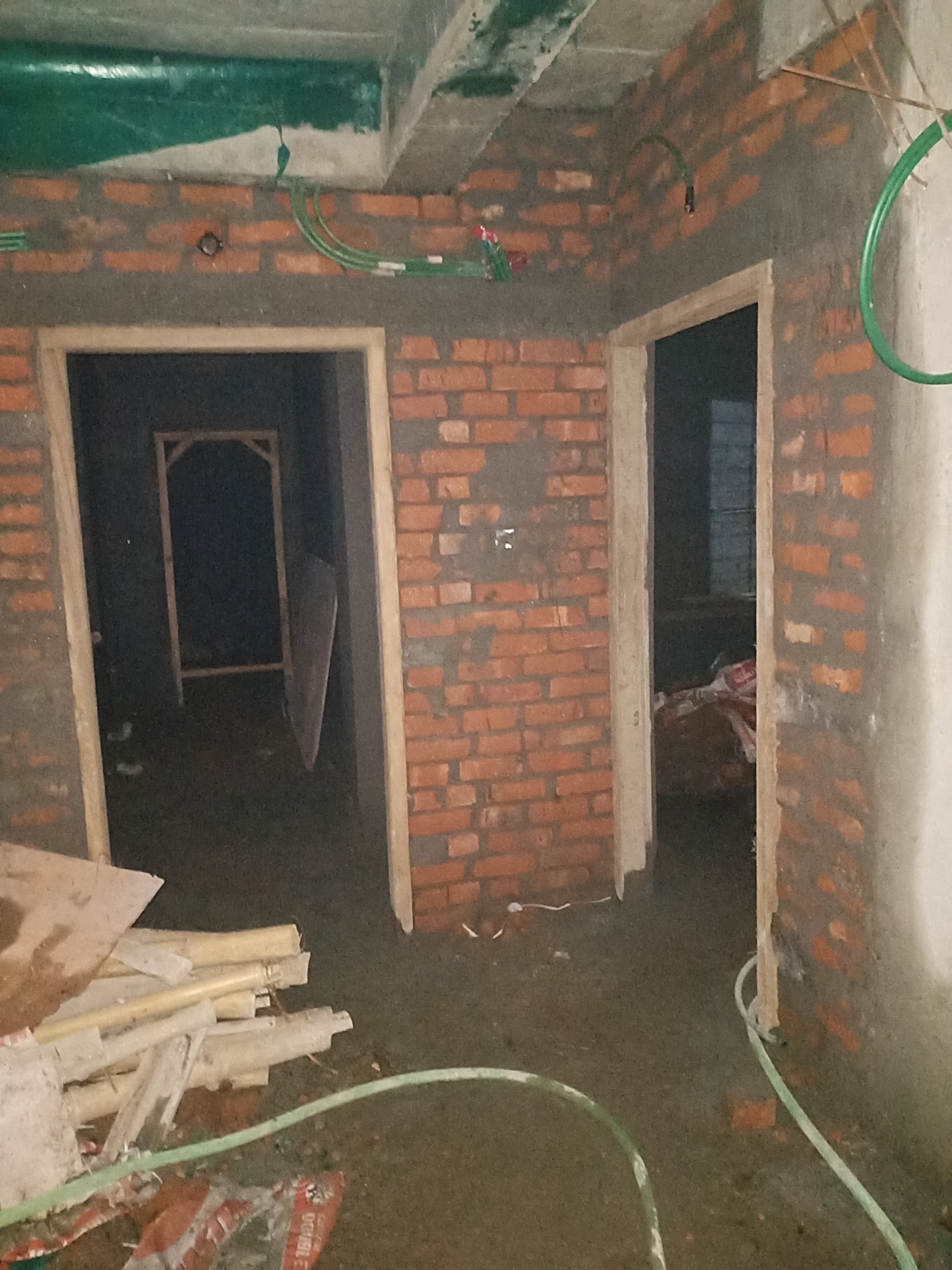

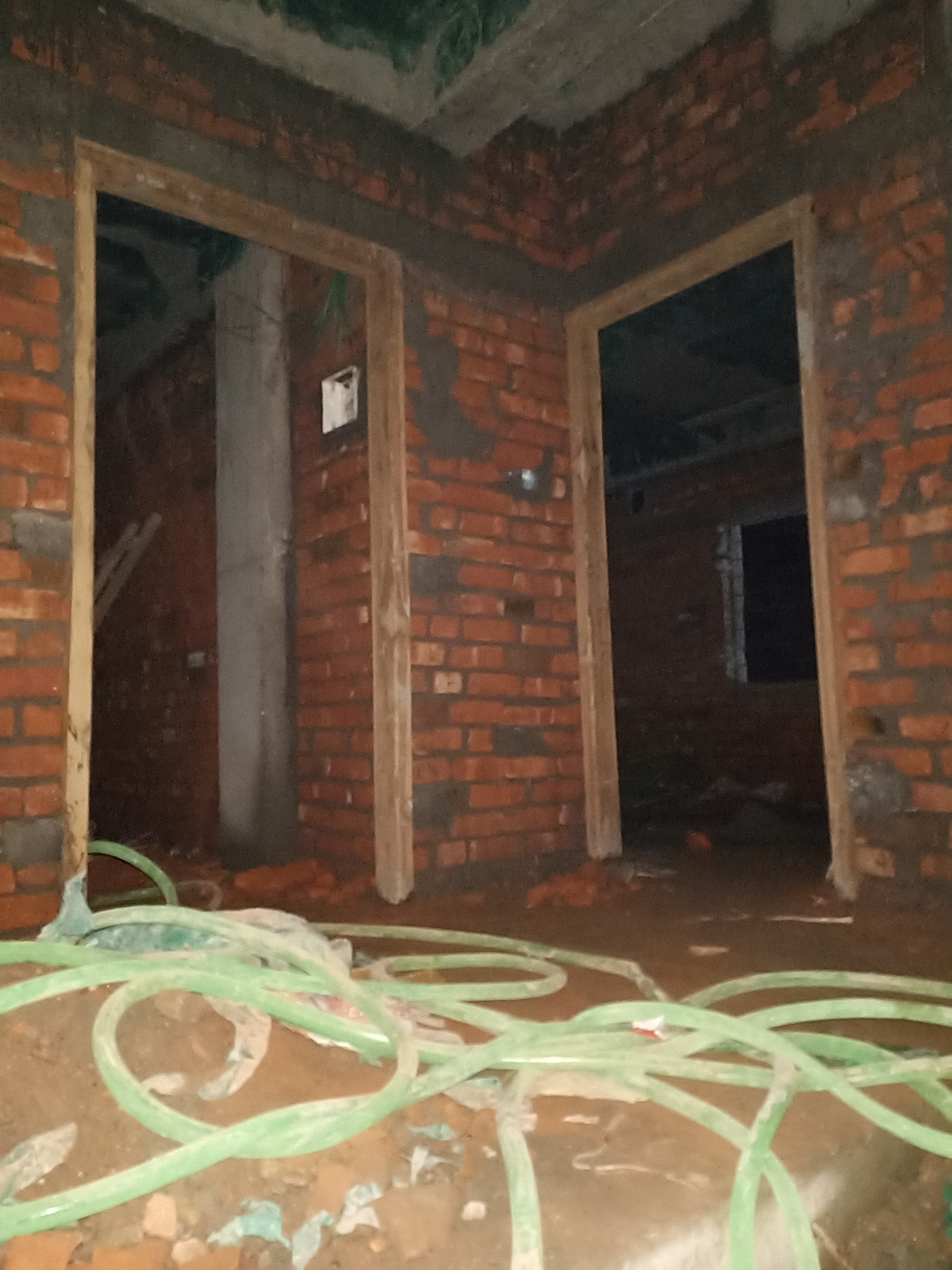

2 BLOCK- B : BRICK WALL FROM GROUND FLOOR TO SECOND FLOOR HAS BEEN COMPLETED AND THIRD FLOOR IS UNDER PROCESS.

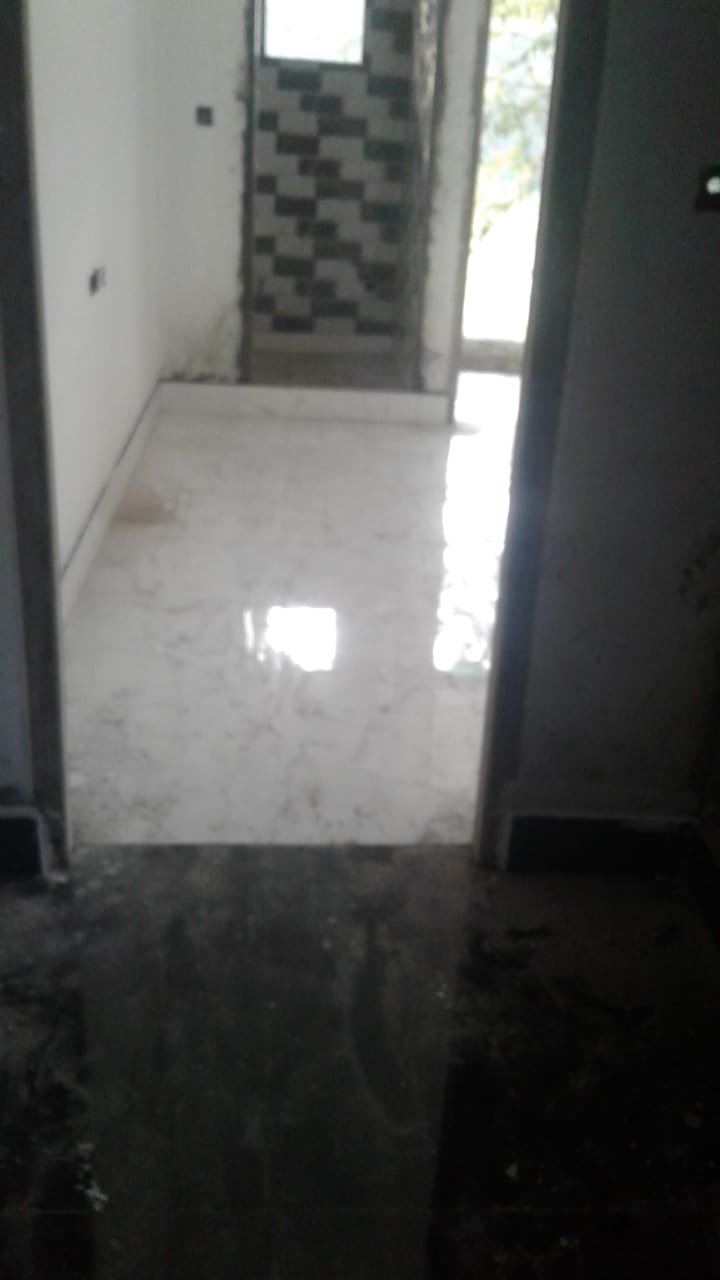

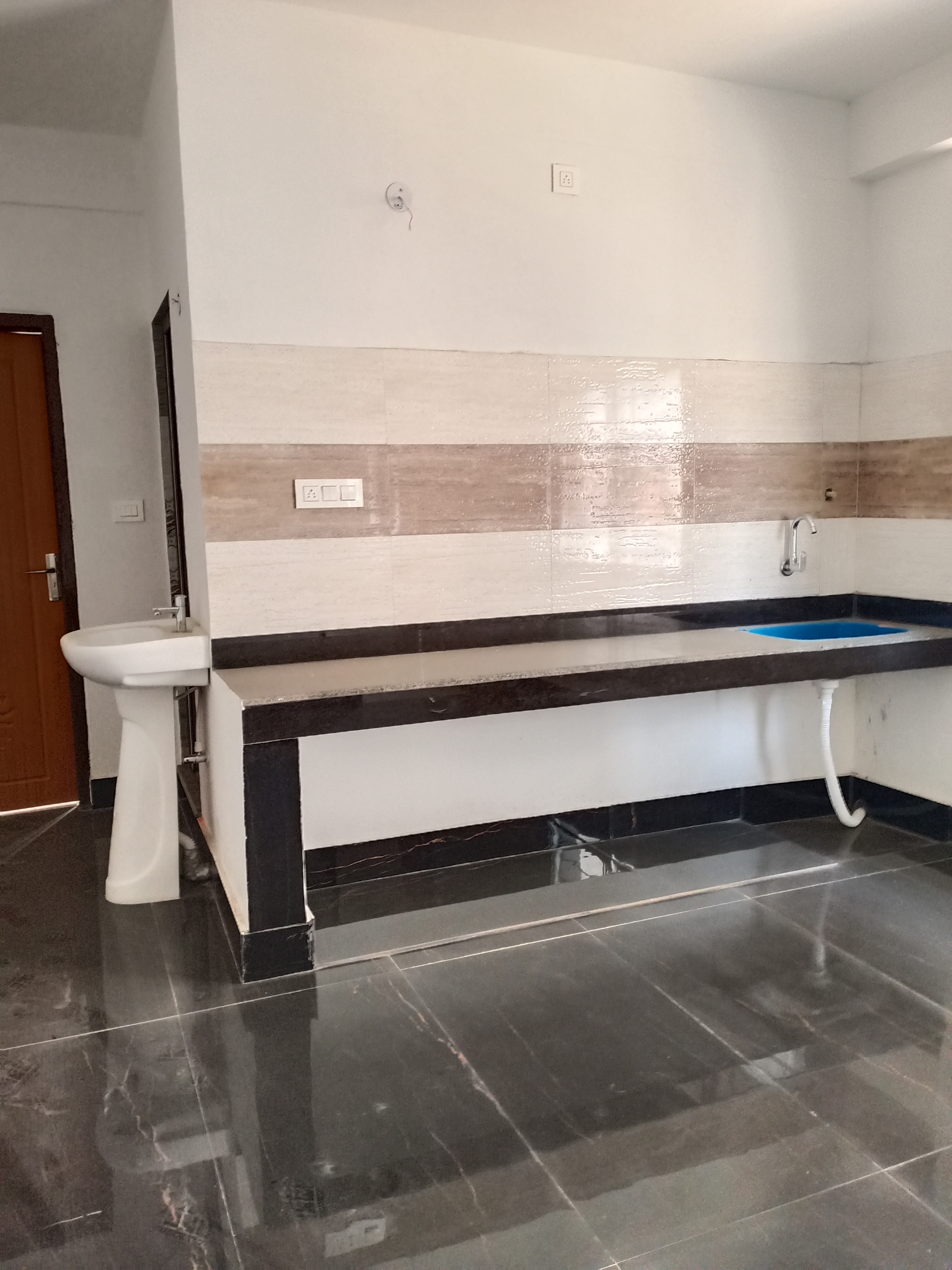

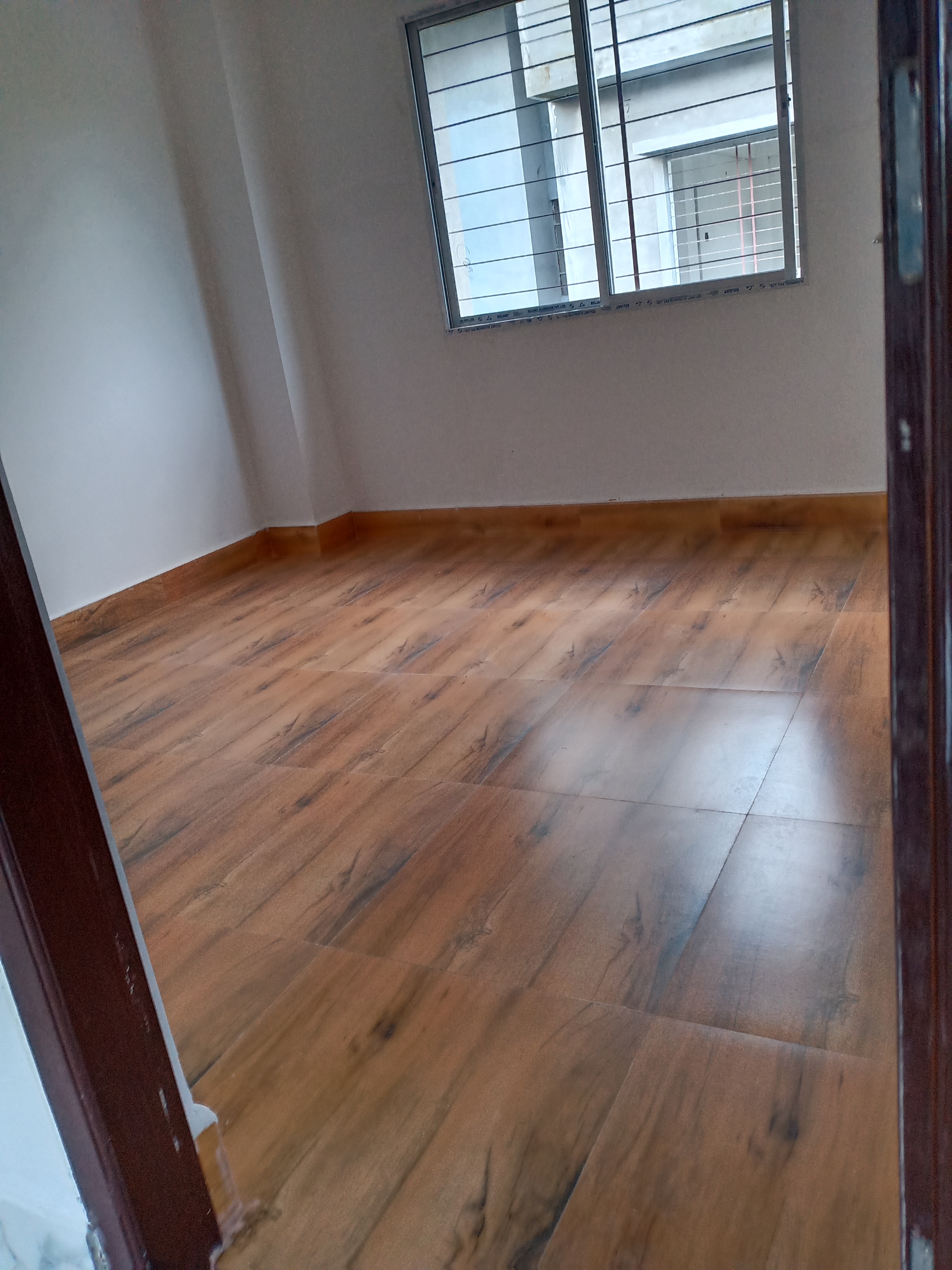

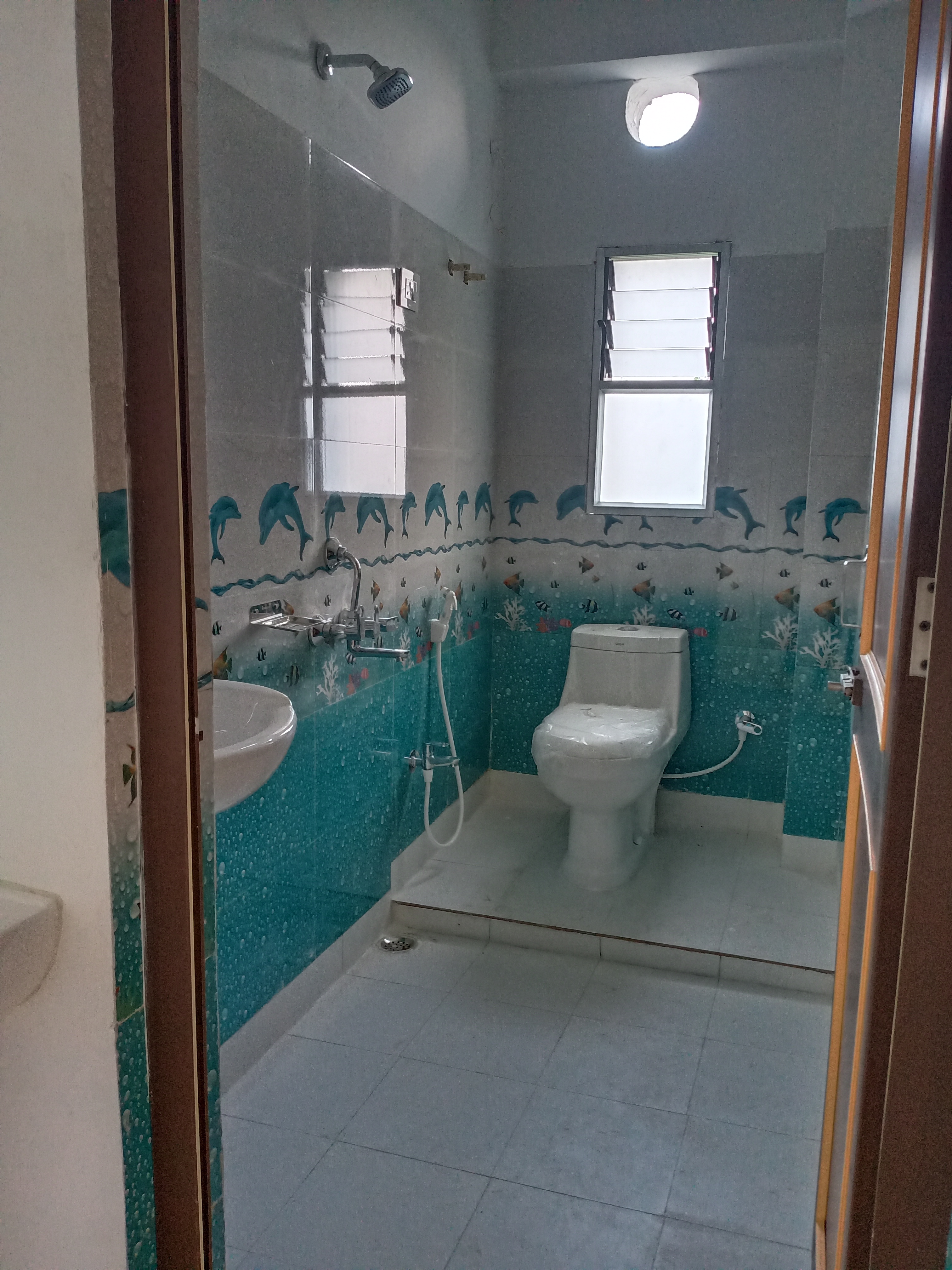

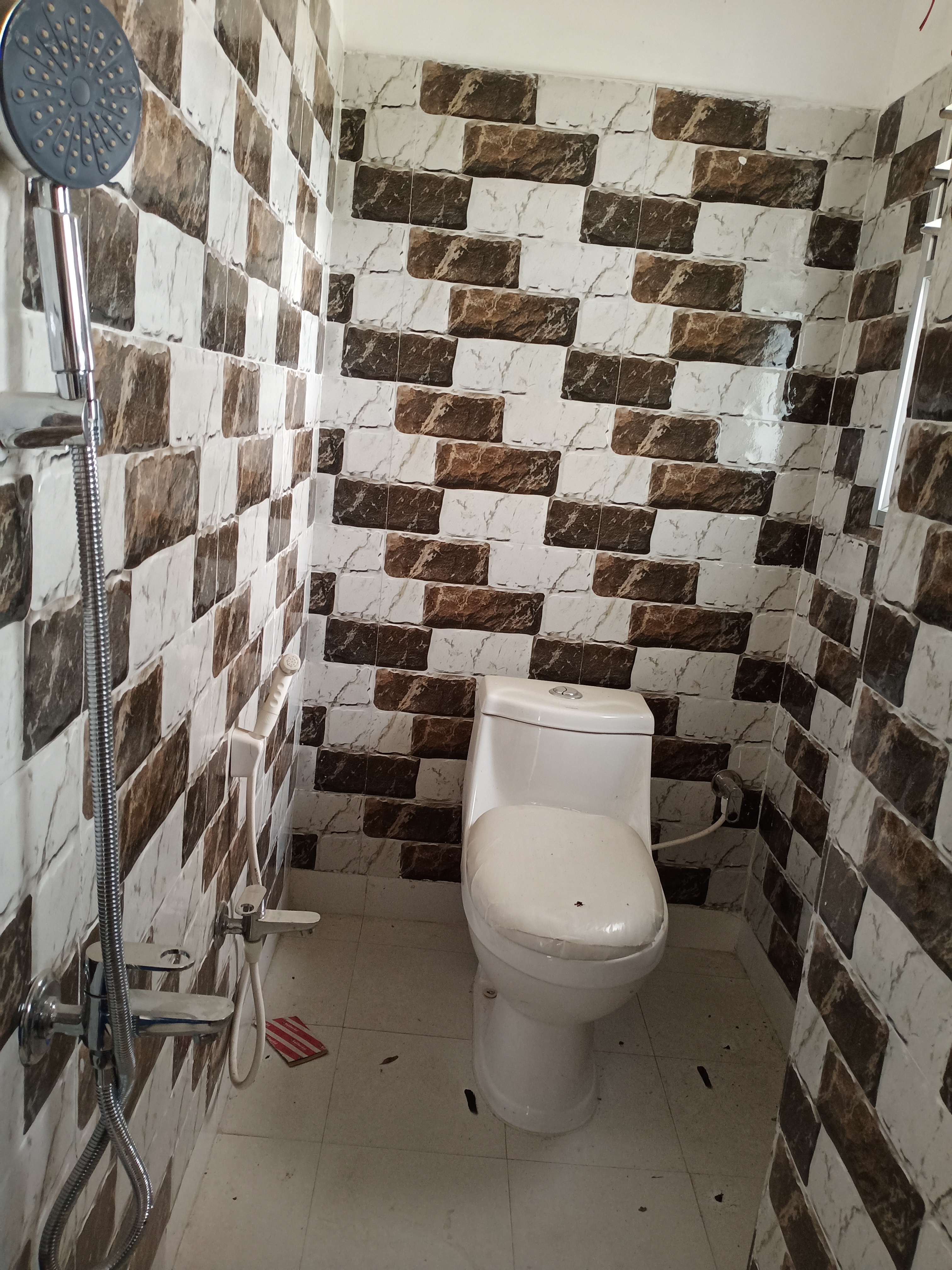

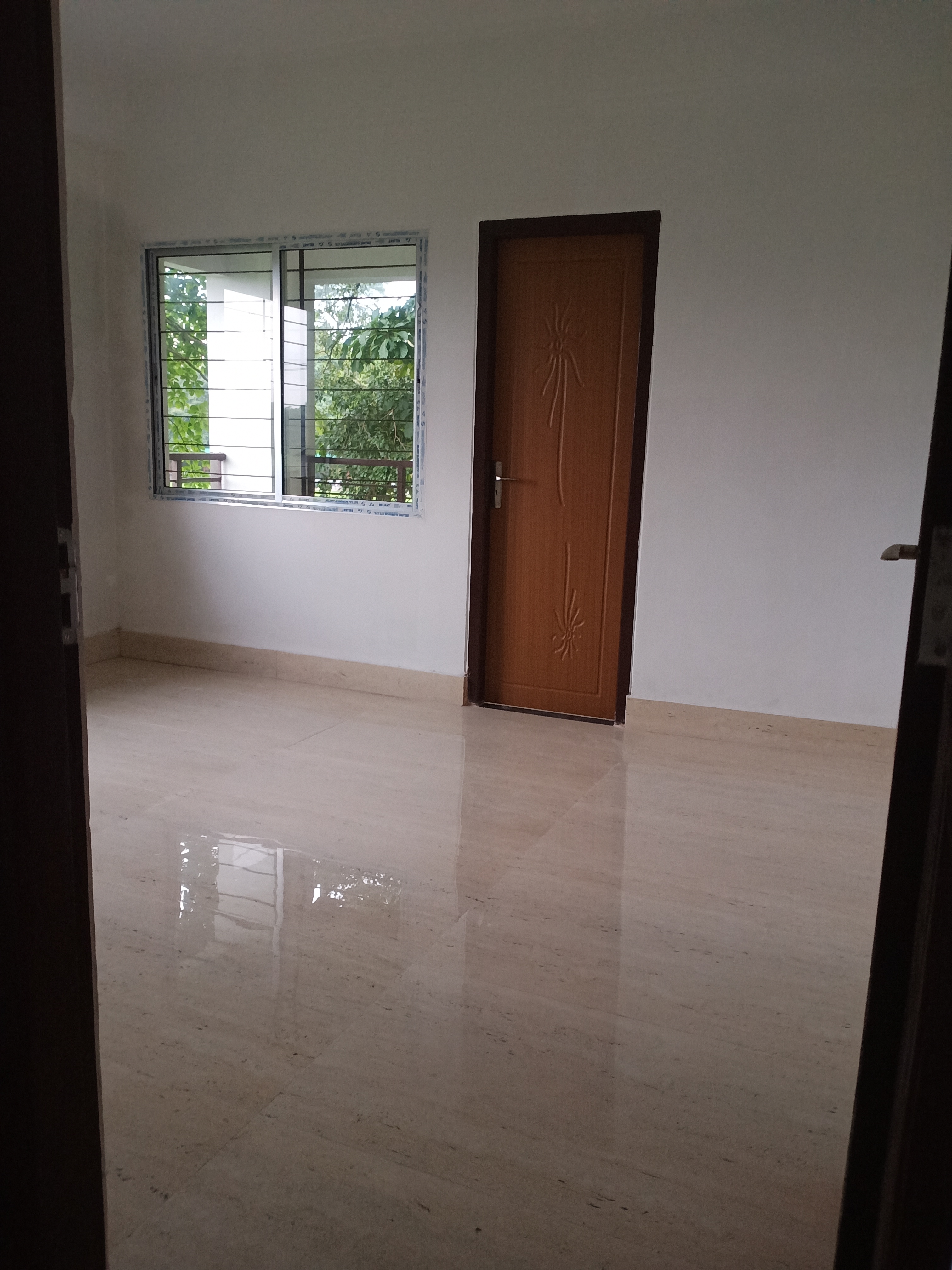

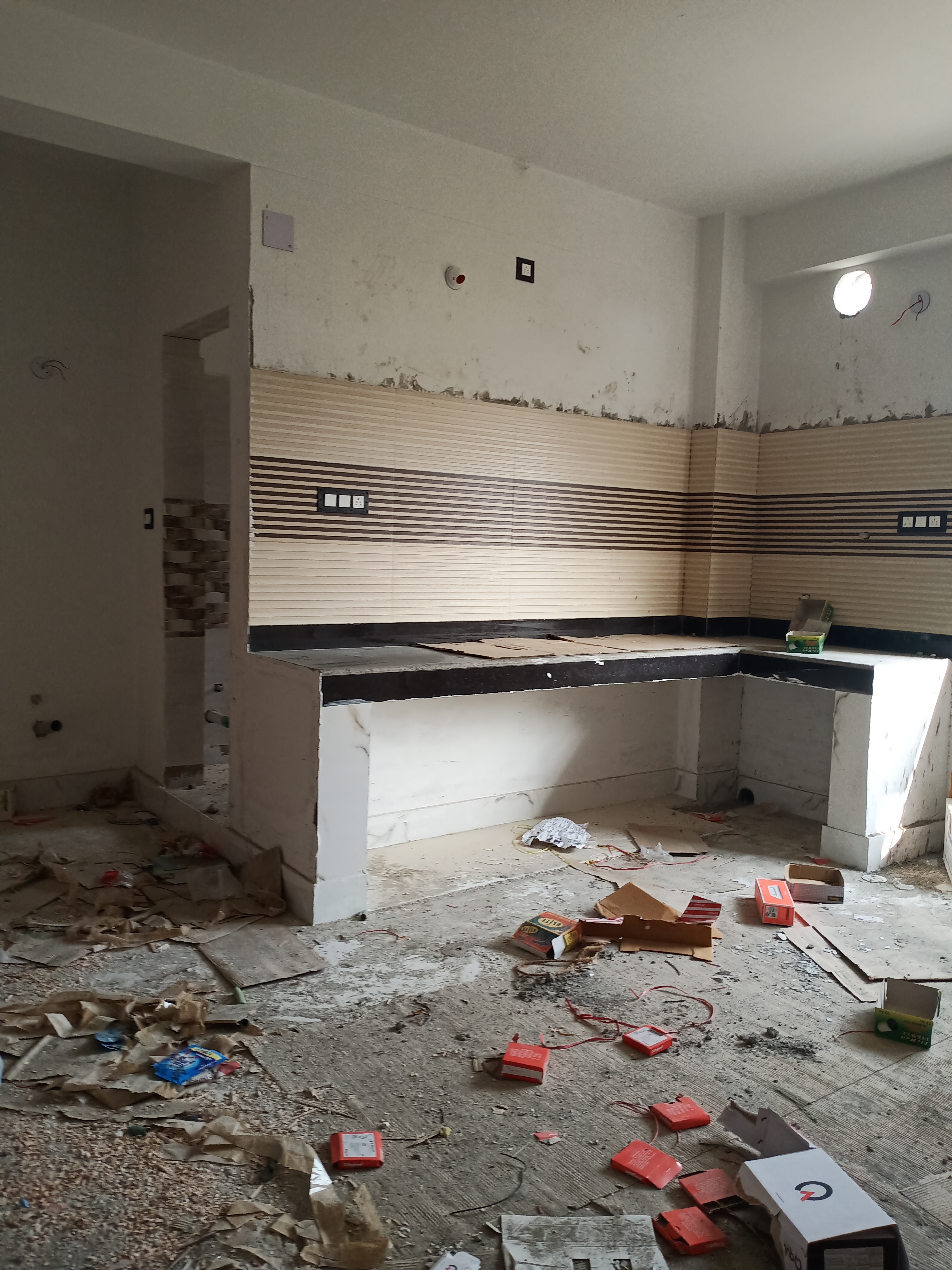

3 BLOCK - A : ALL FLATS FLOORING TAILS HAS BEEN COMPLETED, SANITARY FITTING HAS BEEN COMPLETED, ELECTRICAL FITTING WORKS HAS BEEN UNDER PROCESS.

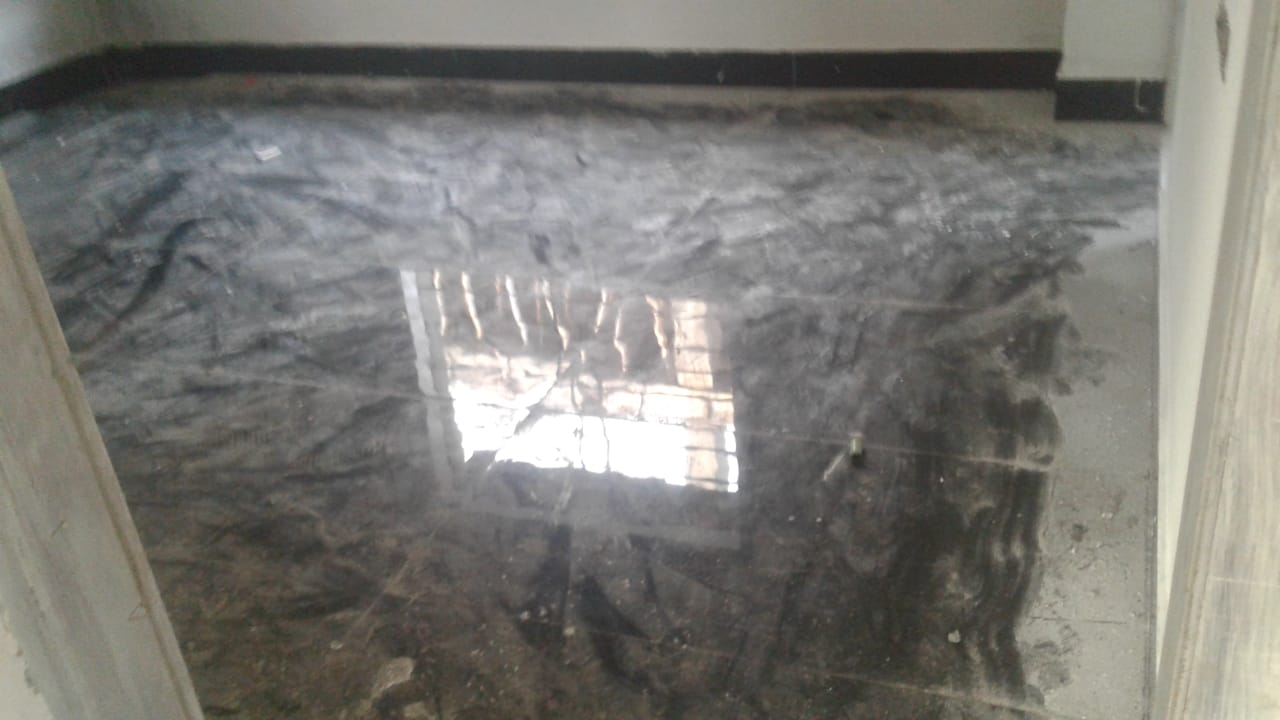

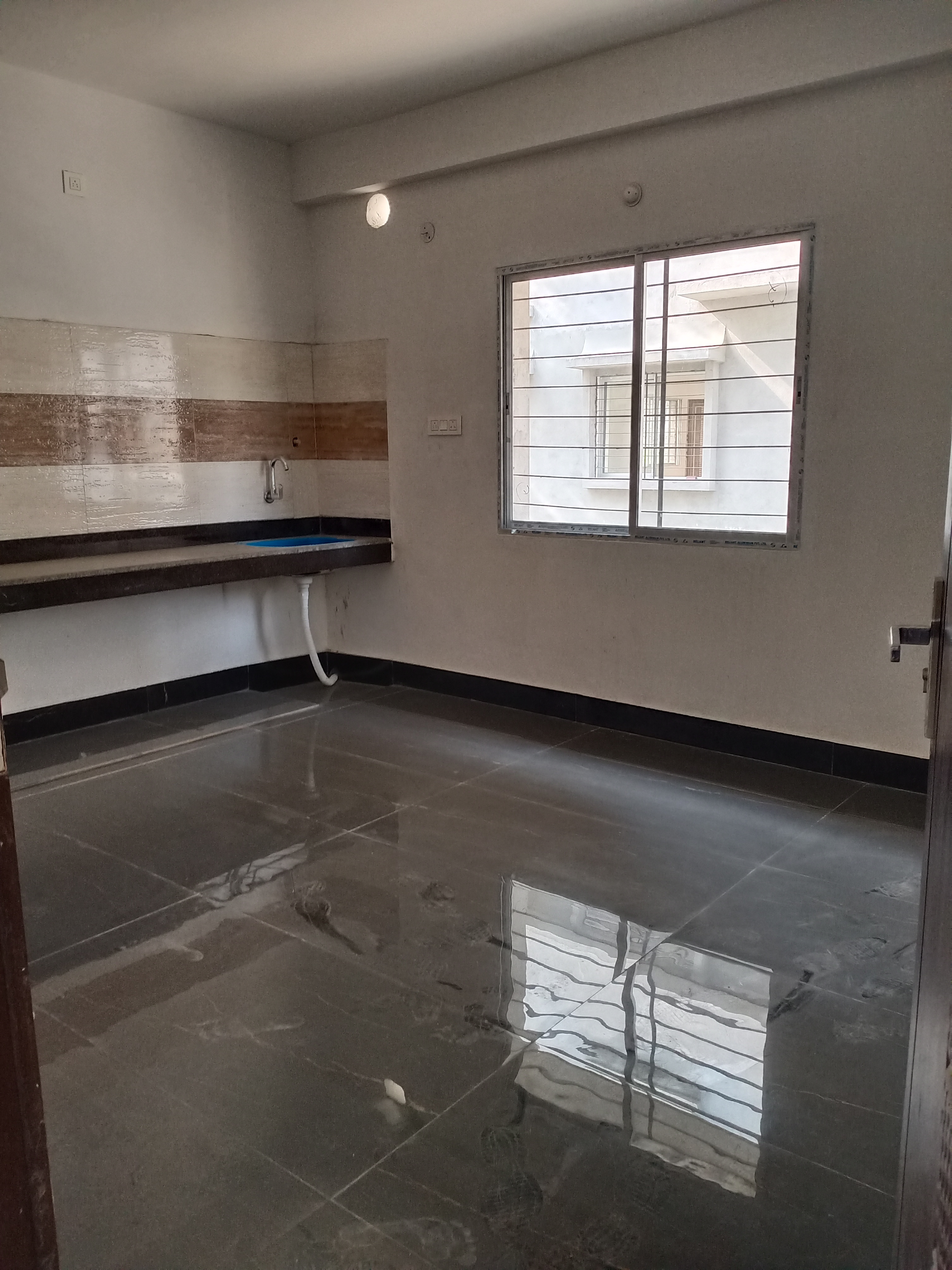

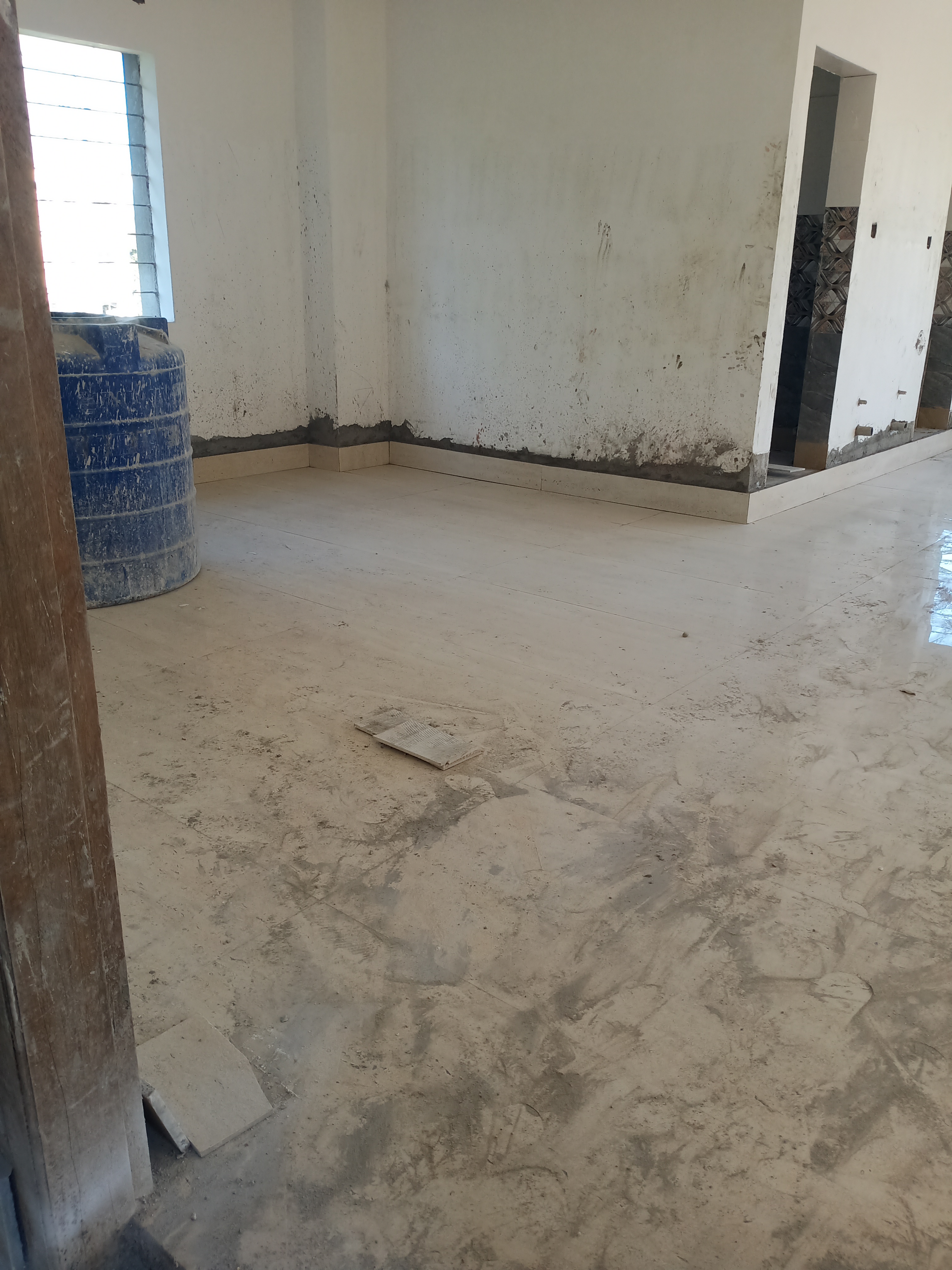

4 BLOCK - B : FLOORING WORKS UNDER PROCESS. ELECTRIC WORK HAS BEEN UNDER PROCESS.
5 BLOCK- A 1ST FLOOR 3 NUMBERS OF FLATS FLOOR TILES COMPLETED, ALL GROUND TO 3RD FLOOR BRICK WALL COMPLETED, GROUND TO 2ND FLOOR INTERNAL PLASTER COMPLETED OF ALL FLATS
6 BLOCK- A 1ST FLOOR 3 NUMBERS OF FLATS FLOOR TILES COMPLETED, ALL GROUND TO 3RD FLOOR BRICK WALL COMPLETED, GROUND TO 2ND FLOOR INTERNAL PLASTER COMPLETED OF ALL FLATS

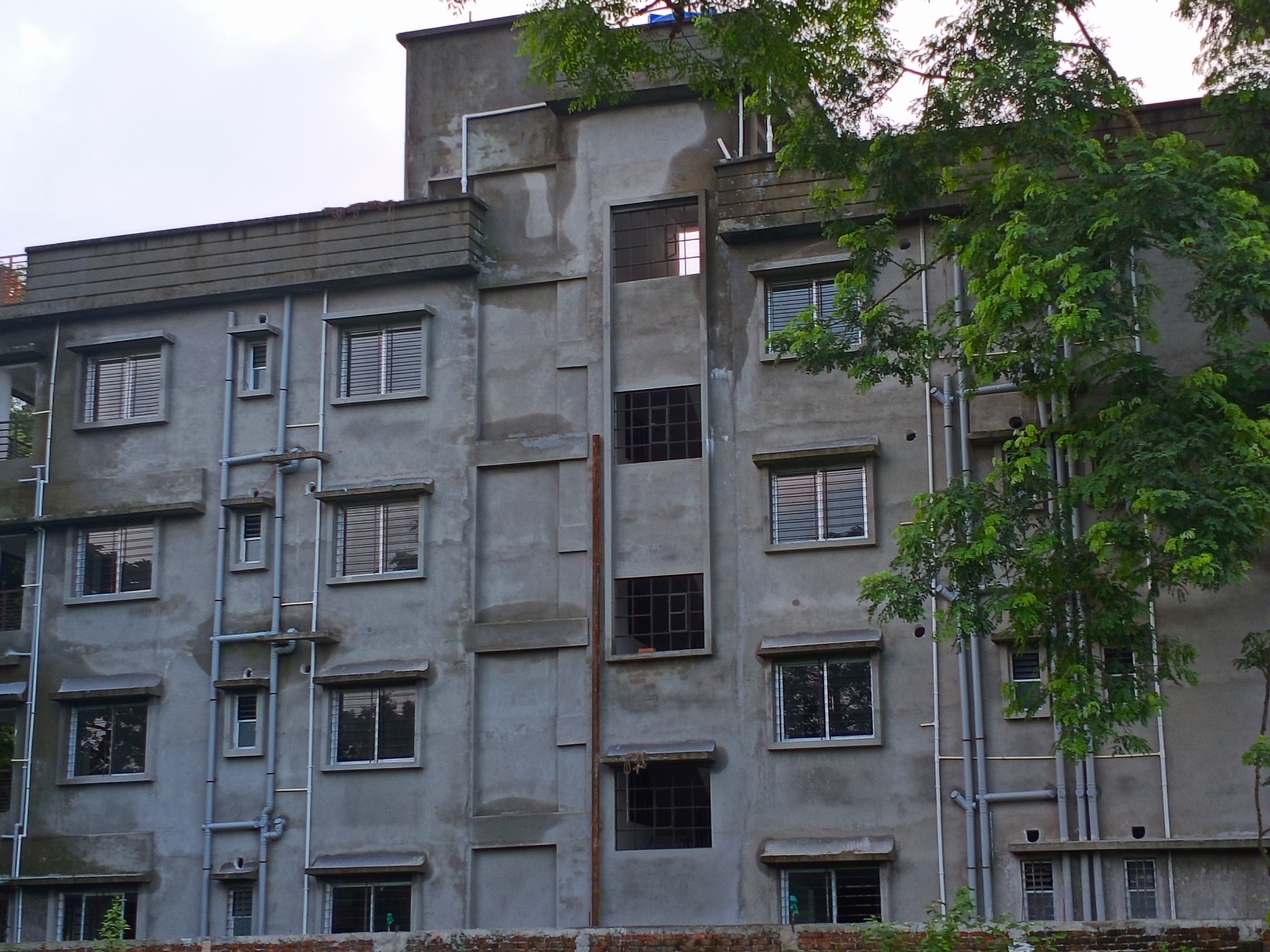

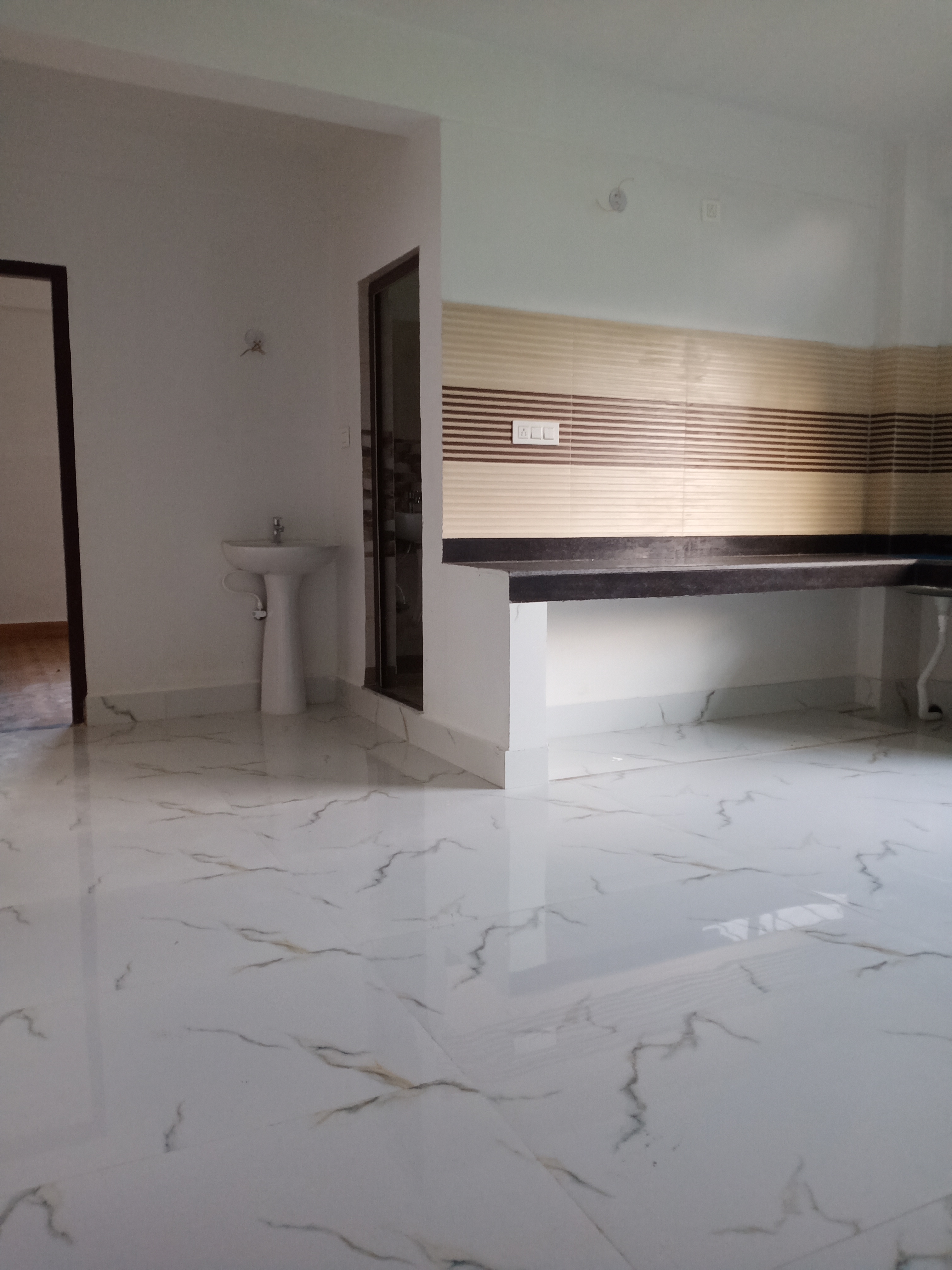

7 BLOCK- A : GROUND FLOOR TO THIRD FLOOR ALL FLATS FLOORING TAILS HAS BEEN COMPLETED. SANITARY FITTING HAS BEEN COMPLETED. FINISHING WORK OF ELECTRICAL FITTING HAS BEEN COMPLETED. OUTSIDE PIPELINE WORK HAS BEEN COMPLETED.
8 BLOCK - B : BRICK WALL HAS BEEN COMPLETED. FLOORING WORKS IS UNDER PROCESS.

9 BLOCK - A : ELECTRICAL WORK FINISH
10 BLOCK B: FLOORING TILES WORKS UNDER PROCESS

Status of Construction of Common Areas with photographs

Sl No. Construction Status Description Download

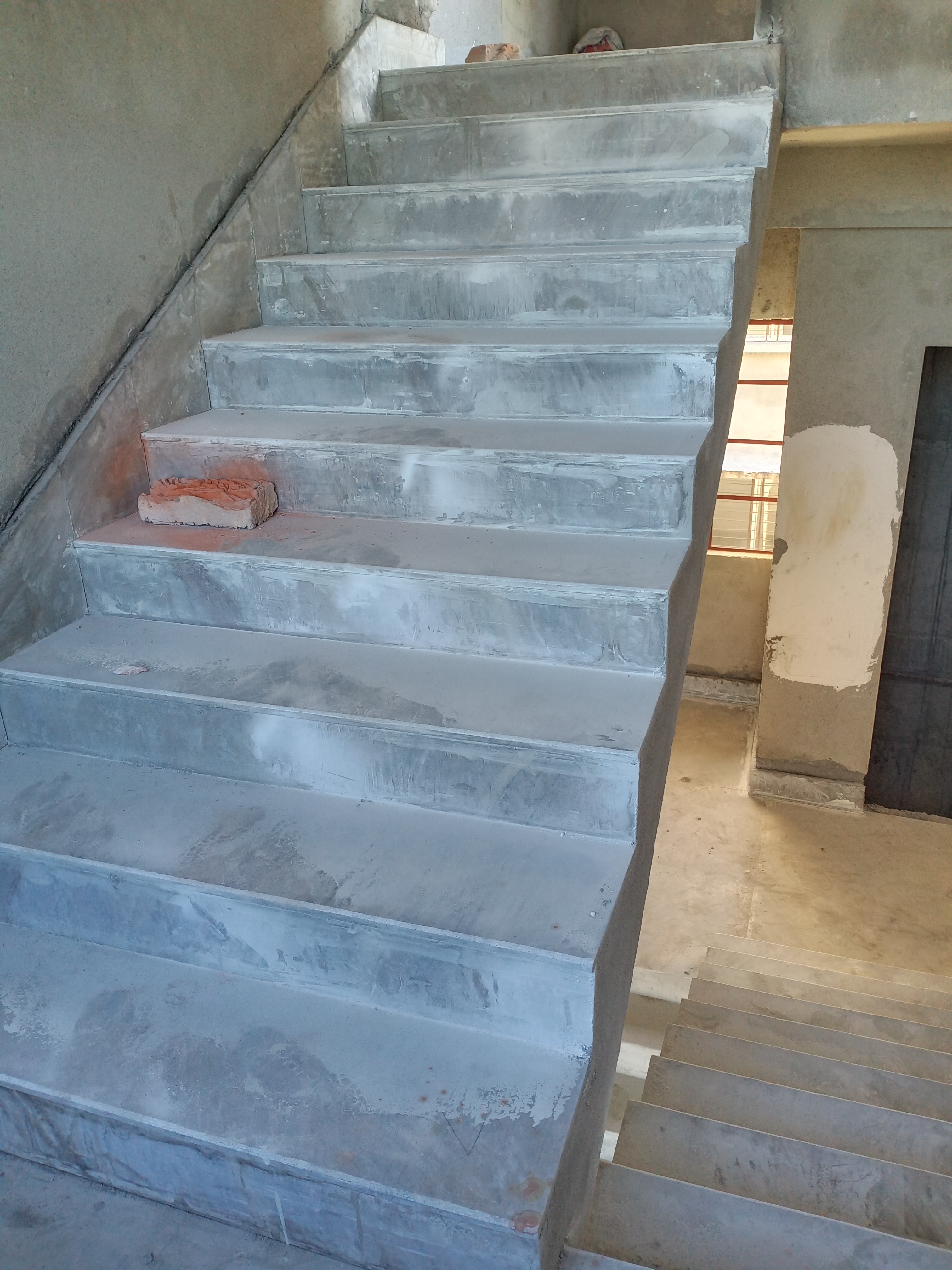

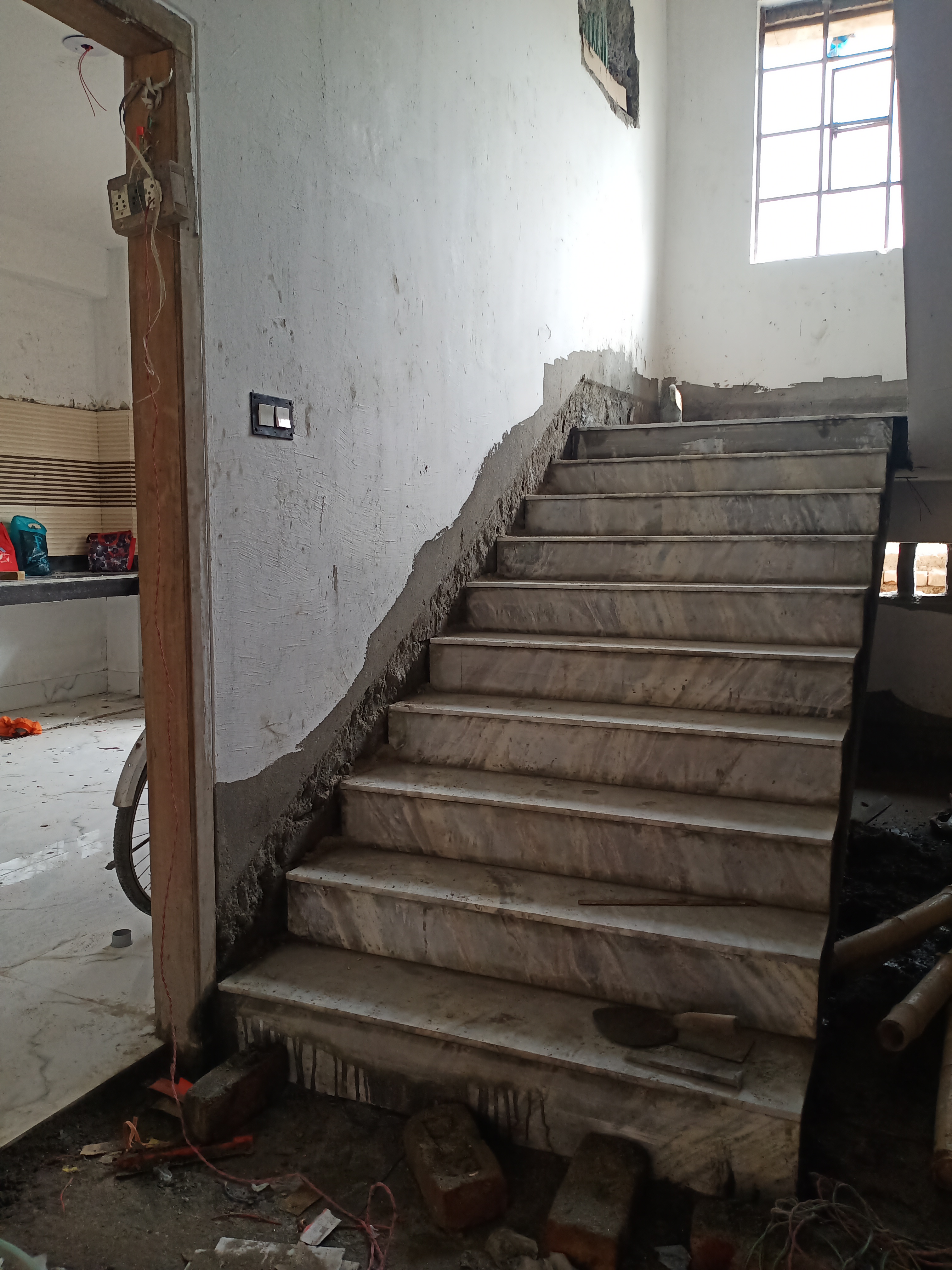

1 Under Construction BLOCK- A: STAIRWAY OF THE BUILDING HAS BEEN COMPLETED AND MARBLE FLOORING FOR STAIRCASE IS UNDER PROCESS
2 Under Construction BLOCK- A: STAIRWAY OF THE BUILDING HAS BEEN COMPLETED AND MARBLE FLOORING FOR STAIRCASE IS UNDER PROCESS

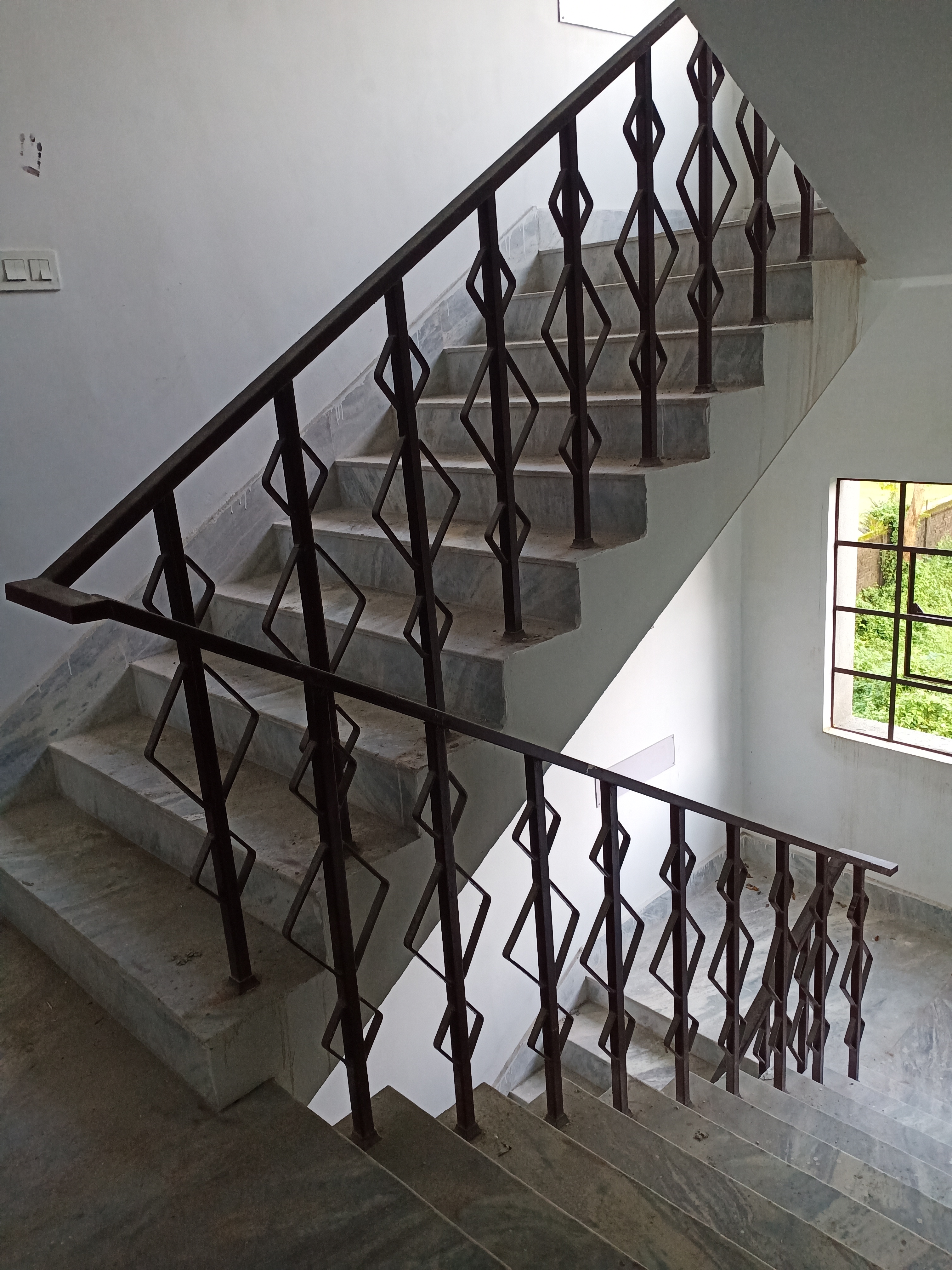

3 Under Construction STAIRWAY OF THE BUILDING
4 Under Construction STAIRWAY OF THE BUILDING
5 Under Construction ROOF OF THE BUILDING

6 Under Construction BLOCK - A : STAIRWAY OF THE BUILDING WITH MARBLE FLOORING HAS BEEN COMPLETED.

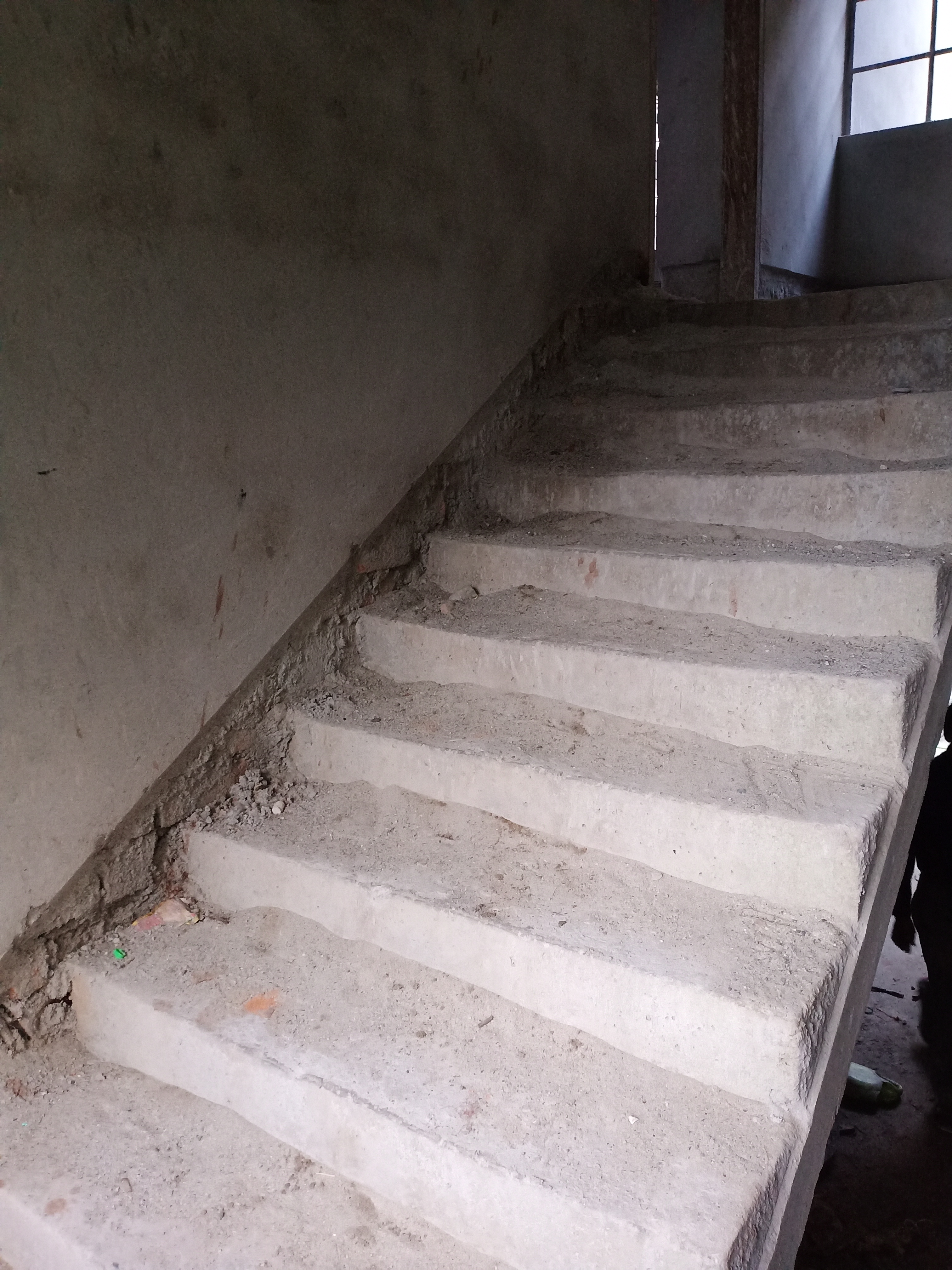

7 Under Construction BLOCK - B : STAIRWAY OF THE BUILDING HAS BEEN YET NOT STARTED.
8 Under Construction STAIRWAY OF THE BUILDING BLOCK -B

Approval for NOC

Approved Document Approval Applied Approval Expected Approval Received Modifications Download
